Reports until 13:39, Tuesday 15 April 2025
H1 SUS
daniel.sigg@LIGO.ORG - posted 13:39, Tuesday 15 April 2025 (83930)
OpLev chassis in SUS-R1

There is an oplev chassis in SUS-R1 that isn't used for anything anymore. I powered it off and it will be removed soon.

H1 General
anthony.sanchez@LIGO.ORG - posted 12:51, Tuesday 15 April 2025 (83928)
Tuesday Mid Shift Update

TITLE: 04/15 Day Shift: 1430-2330 UTC (0730-1630 PST), all times posted in UTC
STATE of H1: Planned Engineering
CURRENT ENVIRONMENT:
    SEI_ENV state: MAINTENANCE
    Wind: 18mph Gusts, 10mph 3min avg
    Primary useism: 0.03 μm/s
    Secondary useism: 0.24 μm/s
QUICK SUMMARY:

Verbals Ops Remider to sweep the LVEA before relocking. Something tells me we are gonna have a long Tuesday maintenance today and may not get around to the LVEA sweep today. :)

Updates on the Upgrades the Following:
Install an ISI in HAM 1.
SPI in PSL - add ALS pickoff mirror - Update, The PSL team had some HVAC issues  stemming from the poweroutage and were delayed.
VAC - HAM1 Top flange Gauge work table side - GM -- Travis has his hands on the new one and wants to install it..... but there is a flying ISI currently in the LVEA.


Norco arrived at exactly 15:00 UTC and drove to the CP2 N2 tank on the +X side of the corner station.

16:00 UTC Test T569591

Second Norco truck arrived 1700 UTC heading Down Y-ARM to Mid Y CP3

18:17 UTC PSL team makes it into the PSL room, after an hour

1 ton taken to dump to offload.

18:45 UTC 2nd Norco truck leaves.

Images attached to this report
H1 SUS
oli.patane@LIGO.ORG - posted 11:05, Tuesday 15 April 2025 (83926)
Populating new filter banks for SR3/PR3

Edgard, Oli

As a continuation from yesterday's work on getting the new noise estimators up and running for PR3 and SR3, we've copied over the filters used in the normal M1 damping for PR3 and SR3, H1:SUS-{PR3,SR3}_M1_DAMP_{P,Y}, for Pitch and Yaw over to new filter banks: H1:SUS-{PR3,SR3}_M1_{PIT,YAW}_DAMP_OSEM and H1:SUS-{PR3,SR3}_M1_{PIT,YAW}_DAMP_EST. These filter banks are found in the Pitch Estim and Yaw Estim screens under OSEM Damper and Estim Damper. The filters were copied over with a script that made sure that it was copying the filters that corresponded to the correct suspension and DOF (some of the filters differ between the suspensions as well as between DOF on the same suspension)..

The filters have all been loaded in but are currently off. The gains on these filter banks are currently set to 0.

I am attaching the script that I used to copy over these filters.

Images attached to this report
Non-image files attached to this report
H1 PSL (ISC, SQZ)
jeffrey.kissel@LIGO.ORG - posted 11:03, Tuesday 15 April 2025 - last comment - 12:14, Tuesday 15 April 2025(83925)
ALS/SQZ Path Monitor PDs Post-vent/Post-Power Outage/Pre SPI Pickoff Install -- vs. PSL Environment
J. Kissel
ECR E2400083
IIET 30642
WP 12453

We're getting started on installing the PSL Pick-off path for the future SPI, and we want to record the values of the ALS/SQZ fiber distribution path before any work gets started -- and also see how these PD's values depend on the PSL environment. These PDs are described thoroughly in LHO:83013, but in short, there's a monitor PD internal to the PSL, on the table, and a down stream fiber-coupled monitor PD inside the ALS/SQZ fiber distribution box.

Note, because ISCT1 has been moved out of the way for the ISI HAM1 install, the ALS COMM 2f SHG power monitor PD is unexpected to be dead, reading zero.

The good news: after the 2025-04-01 corner station vent and 2025-04-06 Power outage (LHO:83753), both ALS/SQZ path PDs report the same power as the did in Feb 2025 -- even though the PMC transmitted power is a few Watts less:
                                            Feb 24 2025           Today (Lights OFF)      Today (Lights ON)
H1:PSL-PWR_PMC_TRANS_OUTPUT       [W]       105.0                 104.6                   104.6
H1:ALS-C_FIBR_EXTERNAL_DC_POWER   [mW]       44.6                 45.15                    45.55
H1:ALS-C_FIBR_INTERNAL_DC_POWER   [mW]       30.2                 29.8                     31.9

In LHO:83013, I reported the *log* of the power for the ALS path PDs rather than the absolute milliwats. Here, I quote both dates in absolute power [mW] for the record.

Watching the long term trend of the PD internal to the ALS/SQZ fiber box, the power swings regularly by ~2 mW. The current max is ~31.5 mW, and min is 29.5 mW.

During this morning's data, PSL environmental controls were on the fritz. My guess is that the optical fiber that feeds the ALS/SQZ internal monitor PD is quite sensitive to temperature, as you can see the INTERNAL power smoothly swing up and down.

The free-space, on table EXTERNAL PD makes sharp 0.3 [mW] jumps when the lights are turned on and OFF, but otherwise no sensitivity to temperature.

Finally, everything moves slightly with the PMC transmitted power, and the slightly smaller, seemingly random 0.2 [W] blips in PMC transmitted power are a result of Jason / Ryan going in and out of the main PSL room to try to assess with the environmental controls and turning on/off the lights.

Upsettingly interesting!

So, here should be our goal powers for on-table EXTERNAL PD and fiber-coupled INTERNAL PD should be somewhere around
    Environmental Controls and Lights OFF
        EXTERNAL / ON TABLE / Free-space PD        45.2 +/- 0.1 [mW]
        INTERNAL / IN RACK / Fiber-Coupled PD      31.2 +/- 0.2 [mW]

    Environmental Controls and Lights ON
        EXTERNAL / ON TABLE / Free-space PD        45.5 +/- 0.1 [mW]
        INTERNAL / IN RACK / Fiber-Coupled PD      30.6 +/- 1.0 [mW]
Images attached to this report
Comments related to this report
jeffrey.kissel@LIGO.ORG - 12:14, Tuesday 15 April 2025 (83927)
UPDATE: Eric rescued the PSL environmental controls after a full system reboot. The systems communications to the actually HVAC had not been recovered since the power outage, so it required a full-system restart. This was complete and the system was functional by 2025-04-15 18:20 UTC.

Attached are the same PD trends as the environmental controls turn on, and the temperature in the enclosure adapts.
The PMC transmitted power went DOWN from 104.6 [W] to 103.7 [W].
The EXTERNAL, on table, free-space PD went DOWN from 45.5 [mW] to 45.2 [mW].
The INTERNAL, fiber-coupled ALS/SQZ distribution box PD became more stable at 31.2 [mW].

So... NEW GOALS for the PDs with the environmental controls on and functioning normally, with the lights on:
    H1:ALS-C_FIBR_EXTERNAL_DC_POWER   45.2 +/- 0.2 [mW]
    H1:ALS-C_FIBR_INTERNAL_DC_POWER   31.2 +/- 0.2 [mW]
Images attached to this comment
LHO VE
jordan.vanosky@LIGO.ORG - posted 10:23, Tuesday 15 April 2025 (83924)
Morning Purge Air Checks 4-15-25

Morning dry air skid checks, water pump, kobelco, drying towers all nominal.

Dew point measurement at HAM1 , approx. -42C

Images attached to this report
LHO VE
david.barker@LIGO.ORG - posted 10:17, Tuesday 15 April 2025 (83923)

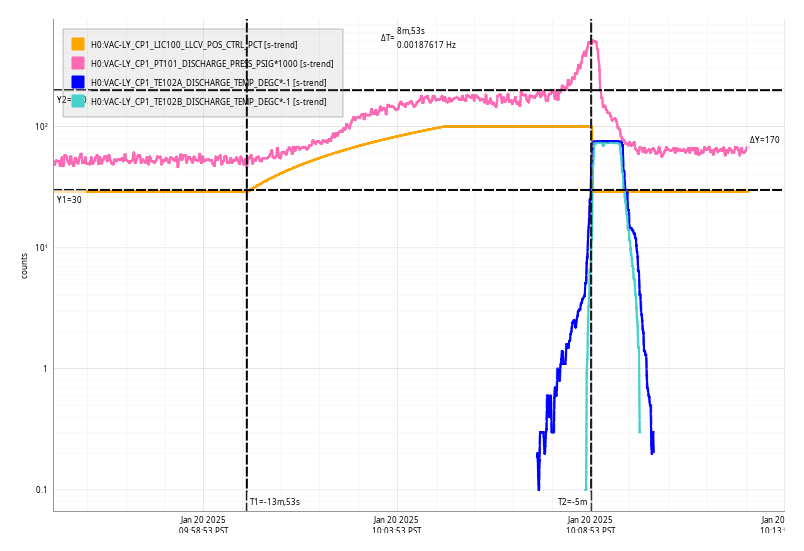

Tue CP1 Fill

Tue Apr 15 10:07:33 2025 INFO: Fill completed in 7min 29secs



Images attached to this report
H1 SUS
edgard.bonilla@LIGO.ORG - posted 10:11, Tuesday 15 April 2025 - last comment - 13:13, Tuesday 15 April 2025(83922)
Added an OSEM estimator folder to the sus SVN

Edgard, Oli, Brian.

We added a folder with a script that calculates the noise budget for the OSEM estimator for an HLTS.

The folder lives in: sus/trunk/HLTS/Common/FilterDesign/Estimator/.

The script inside is called (at least for now) PR3_noise_budget.m, and it uses the simulink diagram in the same folder to run. The diagram doubles as a diagram for the estimator scheme itself, so it can be useful to look at.

We will post more commissioning scripts in this folder later in the week.



Comments related to this report
edgard.bonilla@LIGO.ORG - 13:13, Tuesday 15 April 2025 (83929)

Just ensured the noise budget runs in an operator machine. It needs access to the SusSVN, to the matlabtools folder of the SeiSVN, and access to the ISI2SUS projection matrices saved in /opt/rtcds/userapps/release/isc/common/projections/

The changes are current as of SusSVN revision 12226.

H1 CDS
david.barker@LIGO.ORG - posted 09:46, Tuesday 15 April 2025 - last comment - 15:09, Tuesday 15 April 2025(83921)
GV7 soft closed, alarms bypassed

Travis has asked for a temporary bypass on the GV7 cell phone alarms while this gate valve is soft closed

Bypass will expire:
Tue Apr 15 01:43:34 PM PDT 2025
For channel(s):
    H0:VAC-LX_GV7_ZSM179A_VALVE_ANIM


Images attached to this report
Comments related to this report
david.barker@LIGO.ORG - 15:09, Tuesday 15 April 2025 (83931)

Alarms has been reconfigured to expect GV7 to be soft closed.

H1 General
anthony.sanchez@LIGO.ORG - posted 07:51, Tuesday 15 April 2025 (83920)
Beautiful Tuesday Maintenance Mornin'

TITLE: 04/15 Day Shift: 1430-2330 UTC (0730-1630 PST), all times posted in UTC
STATE of H1: Planned Engineering
OUTGOING OPERATOR: None
CURRENT ENVIRONMENT:
    SEI_ENV state: MAINTENANCE
    Wind: 3mph Gusts, 0mph 3min avg
    Primary useism: 0.02 μm/s
    Secondary useism: 0.26 μm/s
QUICK SUMMARY:

Beautiful day out!  Perfect conditions to Lock H1! But instead the plan is to do the Following:
Install an ISI in HAM 1.
SPI in PSL - add ALS pickoff mirror
VAC - HAM1 Top flange Gauge work table side - GM
PSL/FIL - Moving picomotor driver, pull cables
HAM1 ISC prep - check all removed cables for loose screws, continued
HAM1 ISC prep - Inspect Optics and beam dumps, FC if needed, continued
VAC - Start Feedthru Swap, need Betsy for some cables, continued, mostly done except 1-2 small ones

Hey also this thing is still not reporting back a number when checking the Dust mons.
H1:PEM-CS_DUST_LAB2 Error: data set contains 'not-a-number' (NaN) entries



H1 CDS
erik.vonreis@LIGO.ORG - posted 06:42, Tuesday 15 April 2025 (83919)
Workstations updated

Workstations updated and rebooted.  This was an OS packages updated.  Conda packages were not updated.

LHO VE (VE)
travis.sadecki@LIGO.ORG - posted 17:33, Monday 14 April 2025 (83917)
2025 April vent - VAC diary

Today's activities:

H1 General
ryan.crouch@LIGO.ORG - posted 16:30, Monday 14 April 2025 (83897)
OPS Monday day shift summary

TITLE: 04/14 Day Shift: 1430-2330 UTC (0730-1630 PST), all times posted in UTC
STATE of H1: Planned Engineering
INCOMING OPERATOR: None
SHIFT SUMMARY: HAM1 work is chugging along, the ISI installation structure/fixtures is set up and ready.
LOG:

Start Time System Name Location Lazer_Haz Task Time End
14:15 FAC Randy LVEA N Moving stuff 14:37
14:44 FAC Nellie EndX N Tech clean 14:49
15:14 FAC Nellie LVEA N Tech clean 16:38
15:19 VAC Jordan LVEA N Purge air check 15:25
15:37 FAC Kim LVEA N Tech clean 16:51
15:59 ALS TJ EX, EY N Turning on ALS lasers 16:52
15:59 ISC Matt OpticsLab N Looking for mount 16:15
16:14 VAC Travis, Jordan LVEA N BSC anulus ion pump, CR turned off 18:22
16:25 OPO Sheila, Andrew LVEA N Tech clean 16:43
16:28 FAC Tyler Site N Capital equipment inventory checks 20:06
16:33 FAC Richard, Tony LVEA N Safety checks, out and back in 16:42, 17:30 18:04
16:38 FAC Nellie EndX N Tech clean 17:28
16:49 ISC Betsy LVEA N HAM1 VAC feedthrough check 18:36
16:51 FAC Kim EndY N Tech clean 17:45
16:55 ISC Camilla, Sheila LVEA N HAM5/6 CR, move optics 17:24
17:04 GRD TJ CR N New SEI and SUS GRDs 17:29
17:28 ALS Camilla, Sheila, TJ, Matt, Andrew EY YES ALS beam profiling 19:26
17:52 VAC Jim, Tony LVEA N HAM1 ISI risers installation 18:59
18:07 FAC Randy LVEA N Craning around HAM1 18:52
18:11 ISC Mitch LVEA N Join HAM1 work 18:52
18:16 FAC Richard LVEA N Safety checks 18:32
19:06 SQZ Jeff LVEA N SPI optics 20:25
19:26 EE Betsy, Fil LVEA N HAM1 Cabling, Betsy out 20:20 22:20
19:20 ISC Daniel LVEA N HAM1 checks 20:20
19:28 EE Marc LVEA N HAM1 racks ISC cabling, RMs 22:10
19:43 FAC Randy LVEA N HAM1 work 20:12
20:09 FAC Richard LVEA N Safety checks 21:37
20:11 ISC Jim, Mitch, Corey, Randy LVEA N HAM1 tooling checks, iSI instal supports, Randy out 22:20 22:40
20:12 VAC Travis LVEA N Join HAM1 work 22:00
20:16 VAC Jordan LVEA N Ytube RGA manifold setup/prep 23:29
20:27 ISC Maggie LVEA N Talk to Corey 21:08
21:18 ISC Betsy LVEA N Check with HAM1 crew 21:46
21:28 ISC Camilla, Matt LVEA N HAM5/6 CR optics first contacting 22:43
21:38 FAC Richard LVEA N Safety checks 22:42
22:36 VAC Travis LVEA N Add flange protector HAM! 22:59
22:41 EE Marc Mezz N Investigate power supplies 23:22
22:46 ISC Betsy LVEA N Checks 23:05
23:17 ISC Matt, Camilla LVEA HAM5/6 CR N First contacting optics Ongoing

17:15 UTC a 5.5 from southern California came through

For the trello tasks today:

Images attached to this report
H1 SEI
jim.warner@LIGO.ORG - posted 16:21, Monday 14 April 2025 - last comment - 17:41, Monday 14 April 2025(83915)
Install tooling for HAM1 ISI installed

Randy, Corey, Mitch, Richard, Jim

ISI install fixture was installed today. Like LLO, it was kind of tricky, we installed the back (-Y) stand, Randy drove the first I-beam through and we attached to the -X side of the install fixture. The +Y side of this I-beam was then hung from the crane while we grabbed the second I-beam and attached to the +X side of the -Y stand. The outer +Y stand was then brought in to support the I-beams and we took two of the outrigger legs off the middle stand and used the crane to place it as close as we could to the middle of the I-beams. The -X outrigger was re-attached and we spent some time squaring the whole assembly up to the chamber before attaching the I-beams to the middle stand. We tried to seal the chamber up as good as we can, but we don't really have covers for this step. At this point, the fixture is pretty close to where it needs to be, but we need to set the height and pull the +Y stand out of the way. Should be ready to bring the ISI into the LVea and get started with the ISI install first thing tomorrow.

Images attached to this report
Comments related to this report
betsy.weaver@LIGO.ORG - 17:41, Monday 14 April 2025 (83918)




Images attached to this comment
H1 SUS (SEI, SUS, SYS)
jeffrey.kissel@LIGO.ORG - posted 15:49, Monday 14 April 2025 - last comment - 15:49, Monday 14 April 2025(83906)
OSEM Estimator Infrastructure Installed on HAM2/PR3 and HAM5/SR3
J. Kissel, B. Lantz, E. Bonilla, D. Barker
ECR E2400405
IIET 32526
WP 12459

Using a linear combination of LHO:83724, the google slides in G2402303, and talking to Brian/Edgard who arrived for their week long visit today -- we installed the OSEM estimator infrastructure today on PR3 *and* SR3.

We've only filled in enough infrastructure to ensure that it's function is entirely OFF.
Hopefully we'll get further this week.

The new channels have been initialized in the safe.snap for PR3 and SR3.
    /opt/rtcds/userapps/release/sus/h1/burtfiles/
        h1suspr3_down.snap
        h1sussr3_safe.snap

We made edits to Brian / Edgard's work on common library parts,
    /opt/rtcds/userapps/release/sus/common/models
        HLTS_MASTER_W_EST.mdl
        SIXOSEM_T_STAGE_MASTER_W_EST.mdl
medm screens
    /opt/rtcds/userapps/release/sus/common/medm/hxts
        SUS_CUST_HLTS_OVERVIEW_W_EST.adl
    /opt/rtcds/userapps/release/sus/common/medm/estim/
        ESTIMATOR_OVERVIEW.adl
        CONTROL_6.adl
(see attached notes for details).

And then I made edits to
    /opt/rtcds/userapps/release/isi/h1/models/
        h1isiham2.mdl
        h1isiham5.mdl
to add PCIE Dolphin IPC senders to send out the calibrated ISI HAM ST1 GS13s that are pre-projected into the PR3 and SR3 suspension point euler basis, and then modified
    /opt/rtcds/userapps/release/sus/h1/models/
        h1suspr3.mdl
        h1sussr3.mdl
top level models to receive those IPC, and pipe them in to top of the new main libary part, the HLTS_MASTER_W_EST.mdl

Finally, after Dave installed the model changes and restarted the ISIs and HLTSs, we edited the sitemap
    /opt/rtcds/userapps/release/cds/h1/medm/
        SITEMAP.adl
 to use the HLTS_OVERVIEW_W_EST.adl.

Everything file I mention above has been committed to its respective location in the svn.
Screenshots of stuff will come in the comments.
Non-image files attached to this report
Comments related to this report
jeffrey.kissel@LIGO.ORG - 15:39, Monday 14 April 2025 (83907)SEI
h1isiham2 top level BEFORE vs. AFTER, focusing on the change to the output CART to PR3 EUL Suspension Point projections of IPC senders.
Images attached to this comment
jeffrey.kissel@LIGO.ORG - 15:40, Monday 14 April 2025 (83908)
h1isiham5 top level BEFORE vs. AFTER, focusing on the change to the output CART to SR3 EUL Suspension Point projections of IPC senders.
Images attached to this comment
jeffrey.kissel@LIGO.ORG - 15:41, Monday 14 April 2025 (83909)
Top level of h1suspr3 BEFORE vs. two AFTERs, one focusing on the IPC and the other on the main library block.
Images attached to this comment
jeffrey.kissel@LIGO.ORG - 15:42, Monday 14 April 2025 (83910)
HLTS_MASTER_W_EST.mdl screenshot focusing on where the suspension point signals come in.
Images attached to this comment
jeffrey.kissel@LIGO.ORG - 15:45, Monday 14 April 2025 (83911)
Some detail on the M1 block inside the HLTS_MASTER_W_EST, because I've cleaned up how the ISIFF is added into the ISC signals. This is the SIXOSEM_T_STAGE_MASTER_W_EST block. Part of the cleanup is to create a new subsystem block ADDFF, so we now have EPICs monitors and test points before and after the ADD. These will be useful for commissioning.
Images attached to this comment
jeffrey.kissel@LIGO.ORG - 15:49, Monday 14 April 2025 (83912)
Here's the HLTS MEDM screen overview now, with the new parts highlighted. The second attachment here is a preview of what the infrastructure.
Images attached to this comment
H1 SUS (SUS)
ryan.crouch@LIGO.ORG - posted 12:44, Monday 14 April 2025 - last comment - 15:57, Monday 14 April 2025(83900)
SR3 and PR3 pointing double check

I double checked the positions of PR3 and SR3 before the DAQ restart that's planned for today, SR3 seems to have done a bit of drifting from the LVEA zone4 temperature increasing by ~ 2 degrees. The T cursers denote the power outage. PR3s YAW oplev looks a little different post power outage but its' top mass osems don't really seem to have moved.

Images attached to this report
Comments related to this report
ryan.crouch@LIGO.ORG - 15:57, Monday 14 April 2025 (83914)

PR3 and SR3s pointing after the DAQ restart, the yaw is different.

Images attached to this comment
H1 ISC
camilla.compton@LIGO.ORG - posted 16:56, Friday 11 April 2025 - last comment - 17:06, Monday 14 April 2025(83875)
ISC HAM1 Components

Elenna, Matt, Camilla. Continuing ISC component inspection and prep for re-installation from 83858

Elenna, Matt and I continued to first contact the optics in pans 1 and 2:  M7, M11, M12 (new 90/10 BS), M13, M15 (New 50/50 BS), M16, M17, M18. After again inspecting some of those we cleaned yesterday, we decided to re-clean some. Some needed multiple first contacting, they aren't all perfect (there is a 1" long incredibly hard to see line on M15 and a mark in the center of M18 photo that I will ask a second option on), but otherwise we are calling these two pans of optics ready for re-installation

For M15, I installed the picomotors that I removed from the right handed mount into a left handed siskiyou mount. I installed the manually adjustable actuators removed from the left handed mount into the right handed mount, this will be stored. Notes on how to do this are attached.

Still to be done: decide if M15 and M18 are okay or need swapping, clean optics in pan 3; inspect periscope mirrors; swap out any glass beamdumps we can.

Images attached to this report
Non-image files attached to this report
Comments related to this report
camilla.compton@LIGO.ORG - 13:58, Monday 14 April 2025 (83898)

In this alog, M18 is actually M10, E1000669 S/N 014, HR1064HT532. After speaking with Keita, we plan to replace the optics I couldn't clean, M10 and M15.

I have swapped the pan location of M15 and L2, so that L2 is now M15 is in pan#1 and L2 is in pan#2. This has been updated in the googledoc.

Sheila and I were concerned that the not closed-edge large white cloths could be causing more dust to fall on the optics, but the ones we packed on Friday still looked fine today so we think that is not an issue. We put individual closed-edge white cloths over each optic in pan 2. All the optics in pan 2 (HW1, L2, M7, M17) are clean and ready to install and it's placed back in the HAM3 cleanroom rack.

Images attached to this comment
camilla.compton@LIGO.ORG - 17:06, Monday 14 April 2025 (83916)

This afternoon Matt and I first contacted M1, M5, M6, M14, M18 and the new optics for M10 (E1000669-v1 S/N:?) and M15 (E040512-B1 S/N: 826-08). We're leaving a second coat on M1, M10 and M15 overnight, the center of the others all look good.

Displaying reports 3081-3100 of 84594.Go to page Start 151 152 153 154 155 156 157 158 159 End
