Ibrahim A, Ryan S, Travis S, Betsy W
Context: LHO Welders have finished their training at University of Glasgow IGR and have begun the assessing the status of the LHO welding set-up both independently and in the scenario of welding in the staging building with a reaction chain.
Phase 1: Ryan S and I have conducted a thorough shakedown of all that is needed to begin welding in the staging building. Details on each piece of tooling are informally, but rigorously documented and have been uploaded to the DCC: T2400052-v1. Commentary on all existing documentation (SOPs, HAs, Procedures etc.) is also found there.
Here is a summary list of the tooling, fiber and laser equipment that was checked, transported, installed, documented (I've also included procedures and any pre-existing or updated documentation):
Phase 2: Discuss improvements, brainstorm and/or improve the quality of the set-up. In the same document, below the shakedown is an improvement brainstorm in its infancy - expect this to overtake the document once all necessary tooling is fully documented and shaken down. Here is a summary of future improvement brainstorm and propositions:
We've already started on this first bullet via a more formal spreadsheet is being drafted, though still in early progress, with more specific fastener/assembly details. This is to overcome inneficiencies from searching for correct tooling that can be from different versions, metric/imperial, in different labs and spanning upwards of a decade of welding. Annotated pictures of each weld tooling assembly in its current form will be uploaded too.
The Rough Plan:
The plan right now is not only to practice welding at LIGO under site and scenario conditions, but to inherit this welding set-up in an intuitive and transferrable manner with documentation primarily focused on finding weld improvements and areas to consolidate/simplify parts of the set-up. Obviously no major changes will be made without excessive thought, documentation and collaboration. Through this documentation, we would also allow welding communication to be more streamlined between LHO, LLO, Glasgow and the new CIT weld set-up.
Dave, Richard, Filiberto, Tony, Daniel, Patrick Added to puppet for h1digivideo3 and to MEDM. See attached images. I'm a little worried about the load on this machine, the IOC for this camera has started printing gstreamer queue overrun messages.
TITLE: 02/13 Day Shift: 16:00-00:00 UTC (08:00-16:00 PST), all times posted in UTC
STATE of H1: Planned Engineering
INCOMING OPERATOR: None
SHIFT SUMMARY:
LOG:
Start Time | System | Name | Location | Lazer_Haz | Task | Time End |
---|---|---|---|---|---|---|
16:02 | FAC | Chris. Crane Inspection Person | LVEA | N | Crane Inspection | 23:01 |
16:03 | FAC | Kim. Karen | LVEA, Optics Lab, Vac Prep Lab | N | Technical Cleaning | 16:47 |
16:04 | FAC | Ken | LVEA Entryway | N | Lights | 22:02 |
16:10 | FAC | Tyler | LVEA | N | Crane Inspection Inspection | 18:06 |
16:12 | VAC | Gerardo, Jordan | LVEA | N | Restart Pumpdown | 18:13 |
16:28 | VAC | Travis | LVEA (HAM7) | N | Door Prep | 21:27 |
16:44 | FAC | Kim | EX | N | Technical Cleaning | 17:44 |
16:49 | FAC | Karen | EY | N | Technical Cleaning | 17:49 |
17:27 | FAC | Richard | LVEA | N | Activity Status Check | 18:27 |
17:52 | FAC | Randy, Eric | LVEA (HAM7) | N | HAM7 Doors | 19:24 |
18:16 | VAC | Gerardo, Jordan | LVEA (HAM7) | N | HAM7 Doors | 21:30 |
18:18 | FAC | Karen | FCES (HAM8) | N | Technical Cleaning | 19:18 |
18:24 | SUS | Jason, Ryan C | LVEA (Biergarten) | N | Taking measurements | 18:47 |
18:29 | CDS | Patrick | OSB | N | Updating vac medm screens | 20:32 |
19:23 | SUS | Betsy | LVEA | N | Task Check-up | 19:39 |
19:24 | SUS | Randy | HAM7 | N | HAM7 Doors | 21:23 |
19:34 | CDS | Dave | MSR | N | CDS Week Prep | 20:23 |
19:56 | CDS | Dave | EX, MX | N | CDS Week prep | 20:36 |
21:14 | FAC | Tyler | EY | N | Wind Fence Progress Check-Up | 23:14 |
21:59 | OPS | TJ | LVEA | N | Labeling + Storing | 22:16 |
23:17 | VAC | Gerardo | EX | N | Dew Point Meter Pickup | 23:54 |
23:38 | VAC | Janos | EY | N | AUX Cart | 23:51 |
23:55 | VAC | Jordan | LVEA (HAM7) | N | HAM7 Closeout | 00:55 |
Naoki, Daniel, Nutsinee

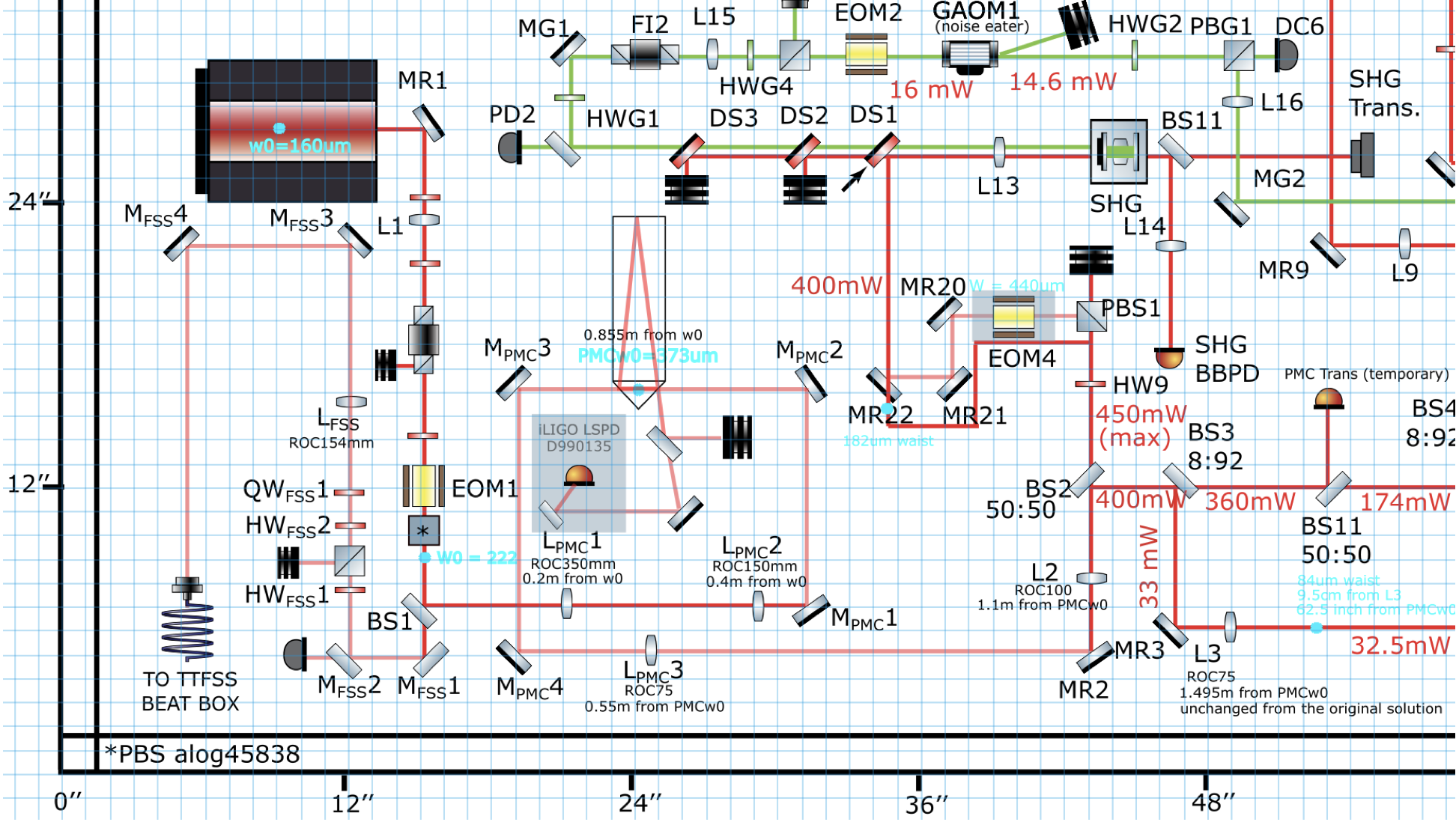

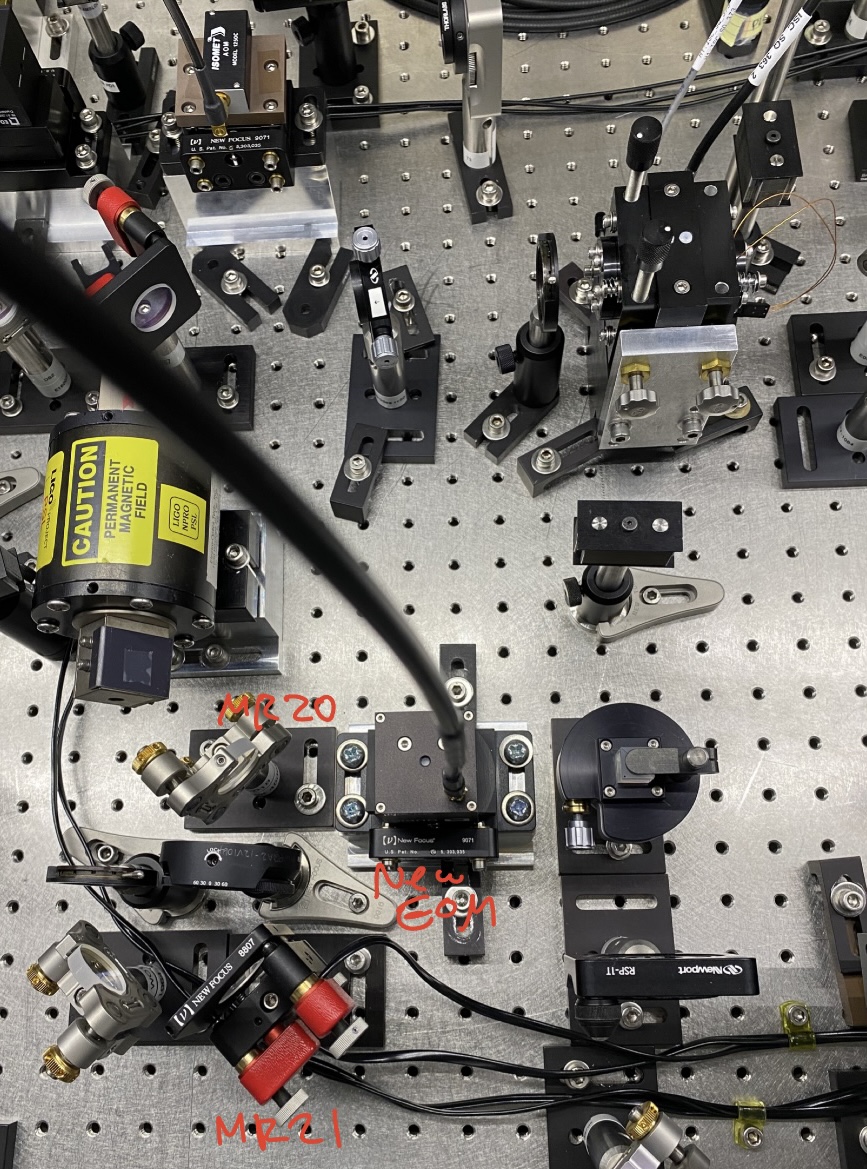

We moved MR20 and MR21 two holes to the left to make room for the new 24 MHz EOM that will now be used to lock the SHG. We're 87% mode matched to the SHG. The higher order mode is dominated by the donut mode (mode mismatch).

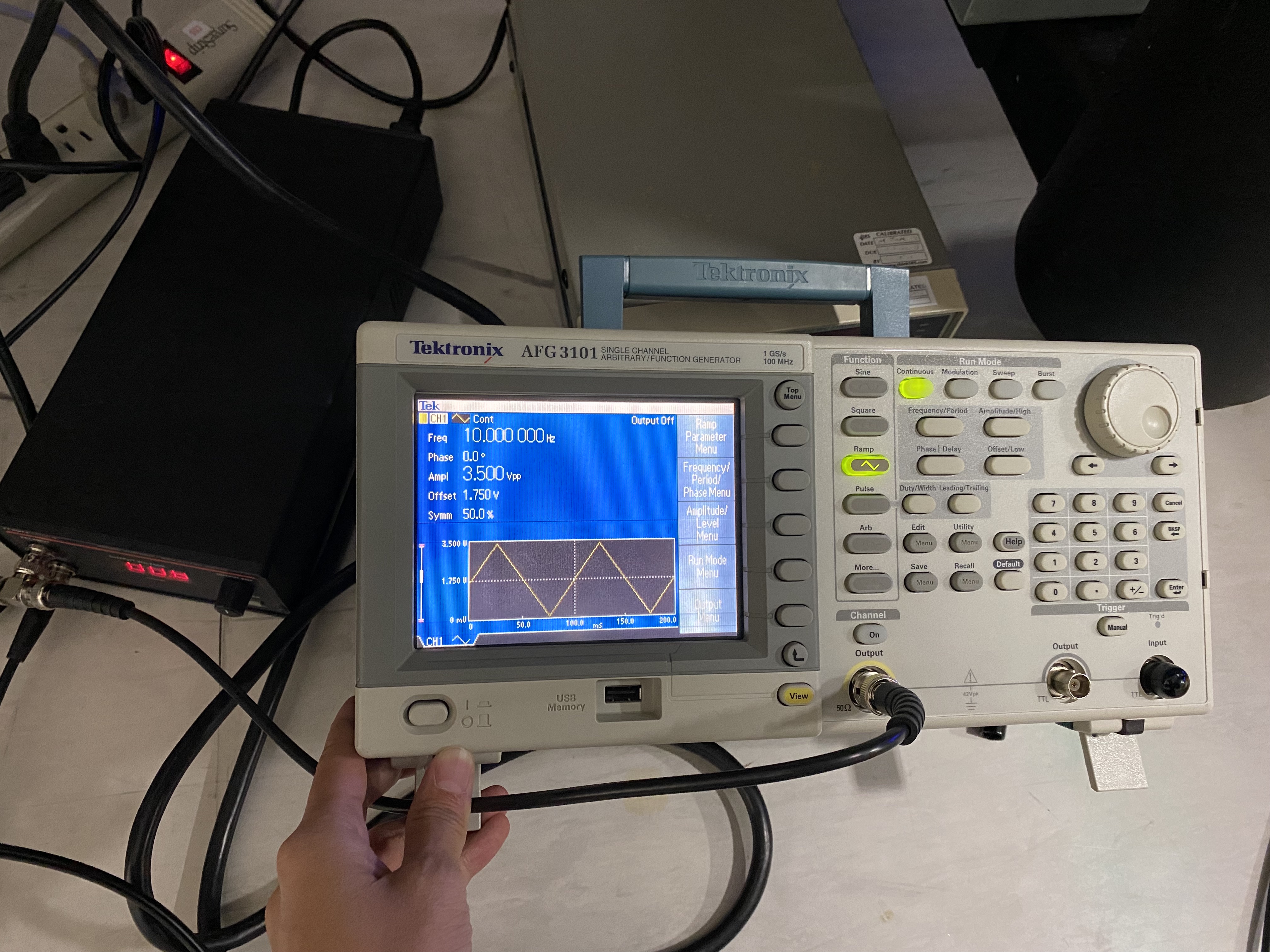

Also attached a function generator settings for the Thorlabs PZT driver so we don't have to figure this out next time.
Naoki, Daniel, Nutsinee

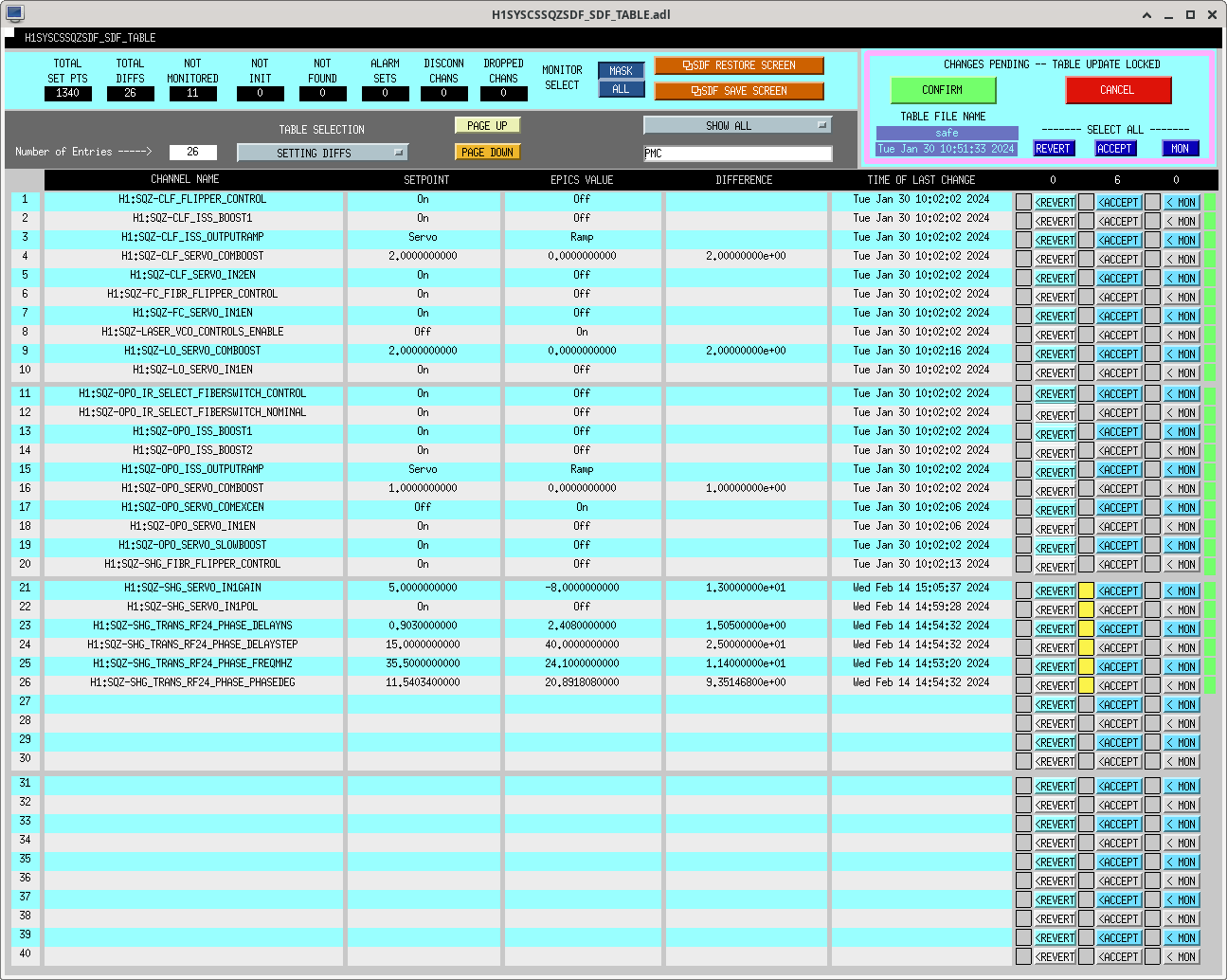

We sucessfully switched to 24.1 Hz locking for the SHG. We gained about a factor of 5 in error signal Vpp. SHG common mode gain was set to 5 dB before, now it's -8 dB. The locking sign is also flipped. Naoki put the new gain in the SHG Guardian and accepted the SDF.

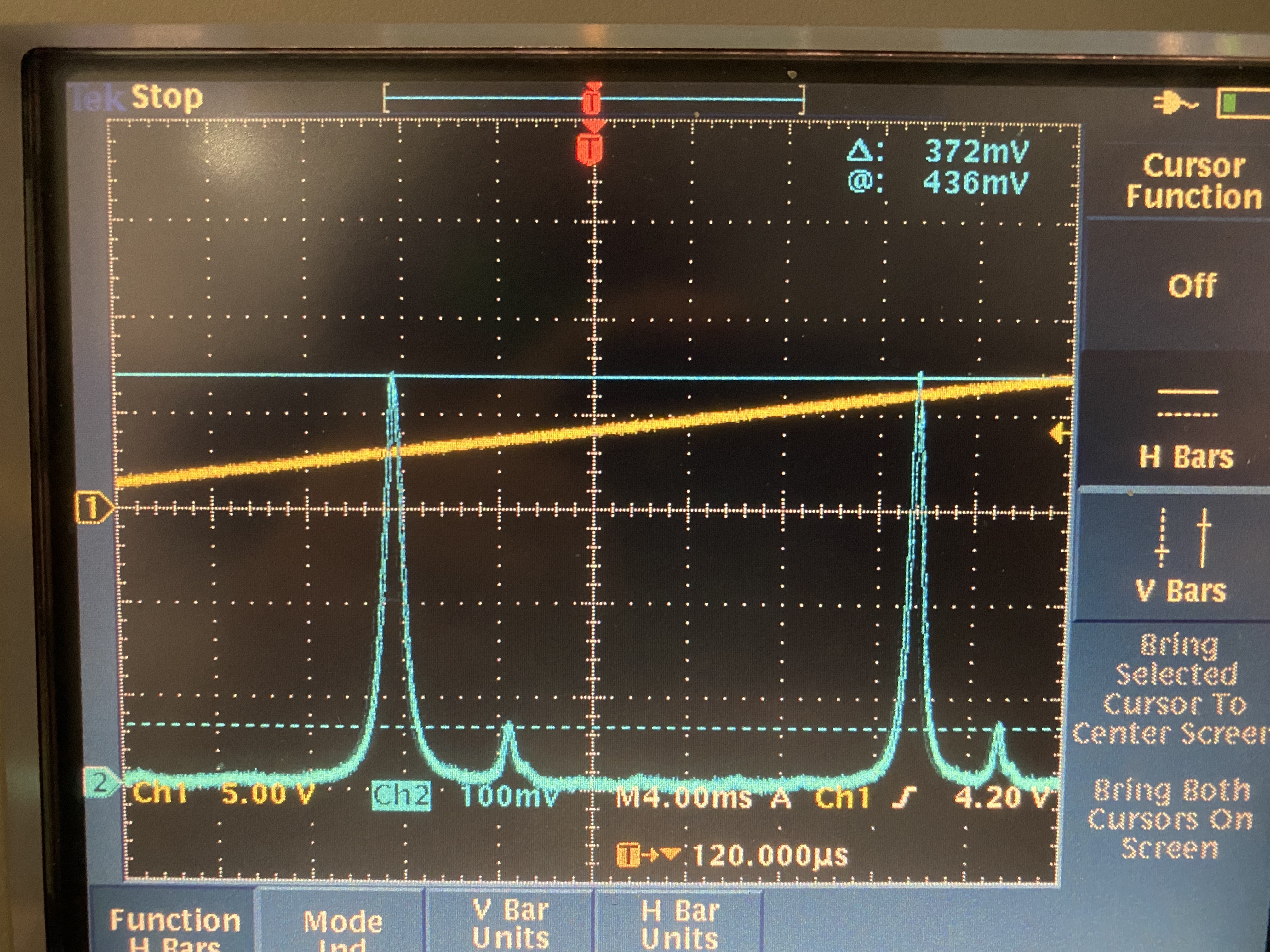

According to the data sheet the modulation index coefficient is 0.14-0.16 Γ/Vpp. Assuming we have around 13dBm of 24.1MHz available at the EOM, we excpect Γ~0.42 (or about 9% of the laser power in RF). This seems a lot.

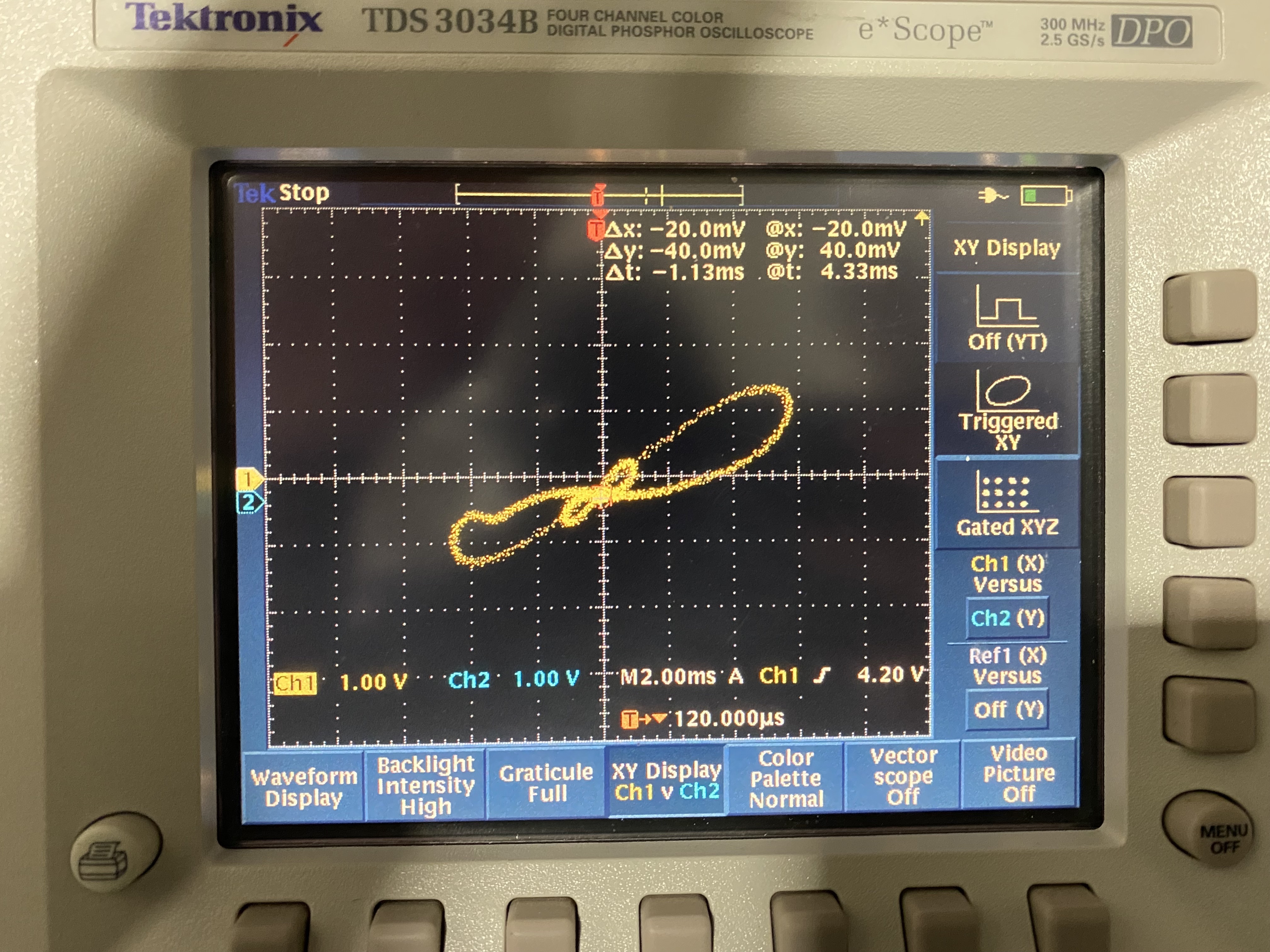

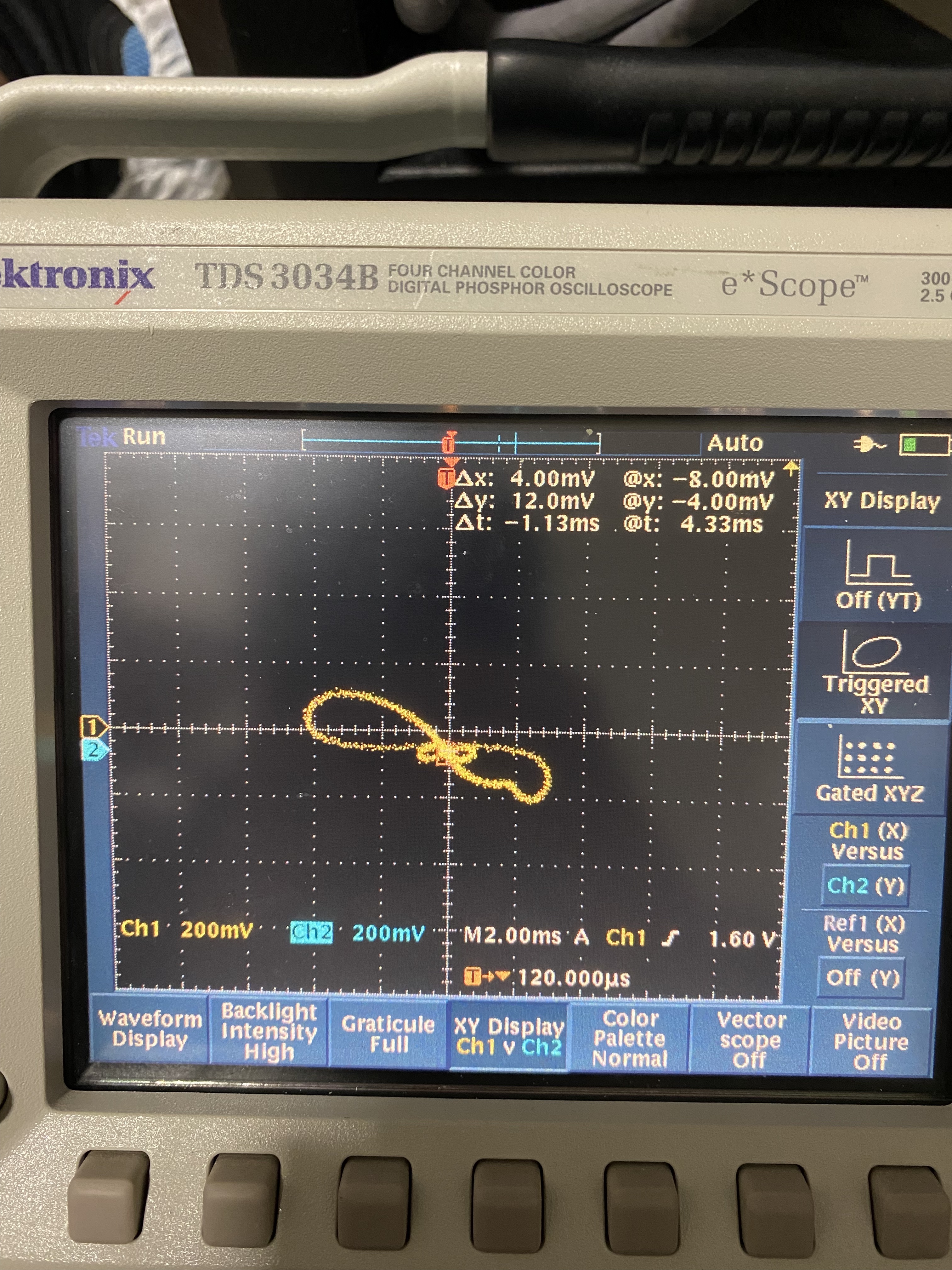

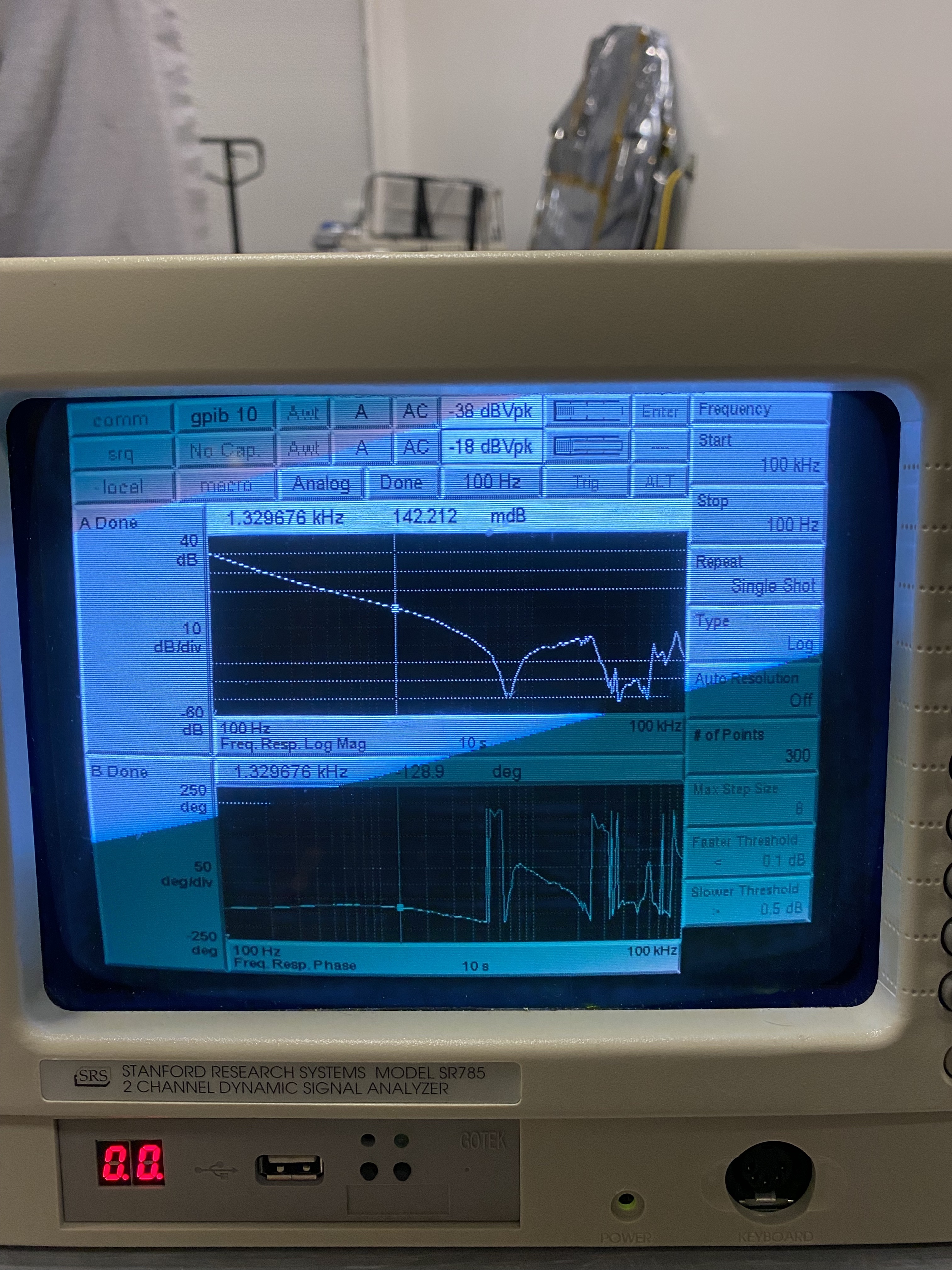

A 10dB attenuator has been added to the modulation input to reduce the modulation index by ~3.
Hanford fire department are refilling their trucks with hydrant water as part of the tumbleweed buring operation. The FMCS alarm for fire pump 1 running was sent to cell phones. I have bypyass this alarm for now.
This is a nice test of the new FMCS software detecting fire pump running status.
Updated T2400046 Googledoc. No leaks, flowmeters look good.

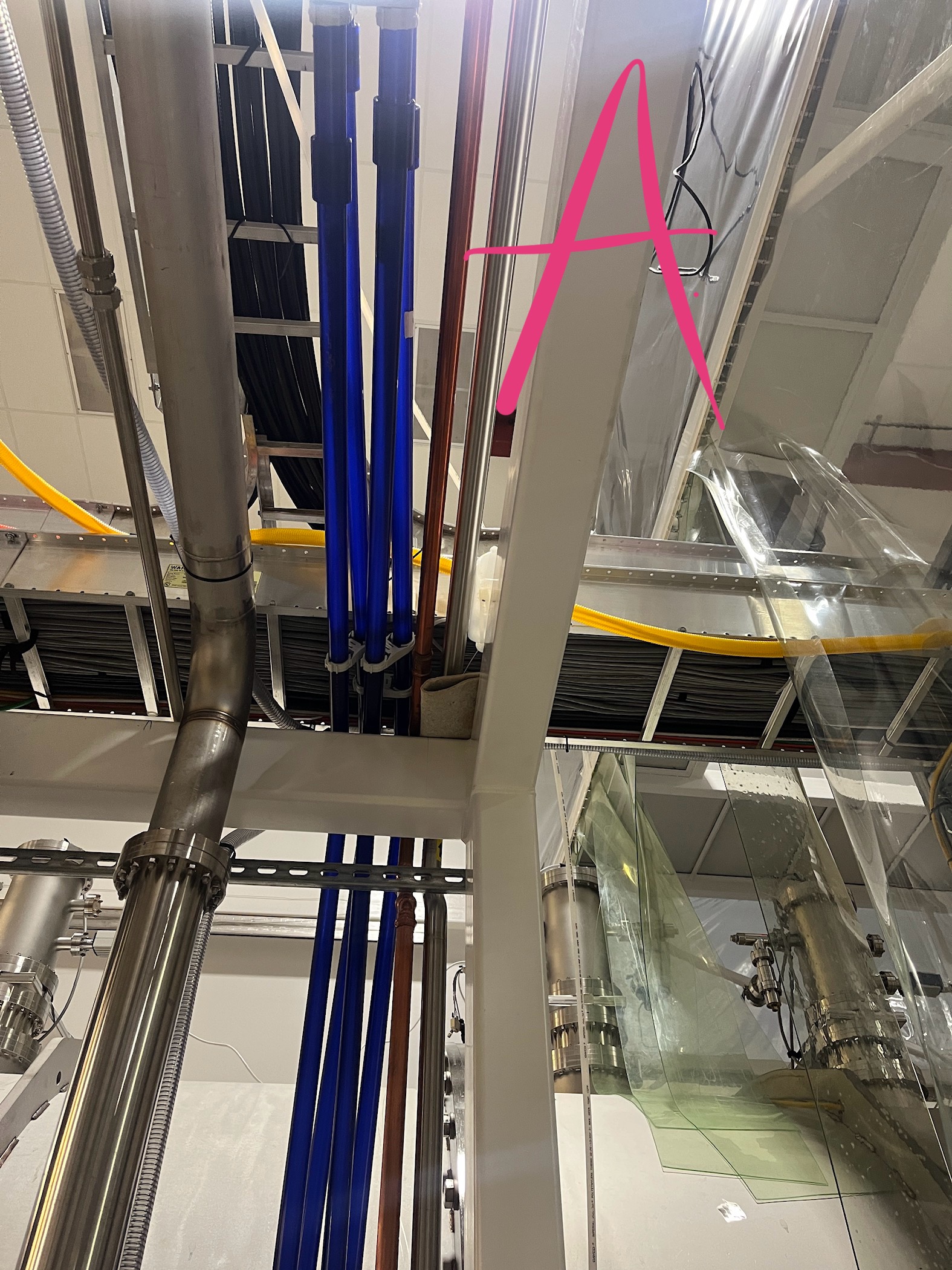

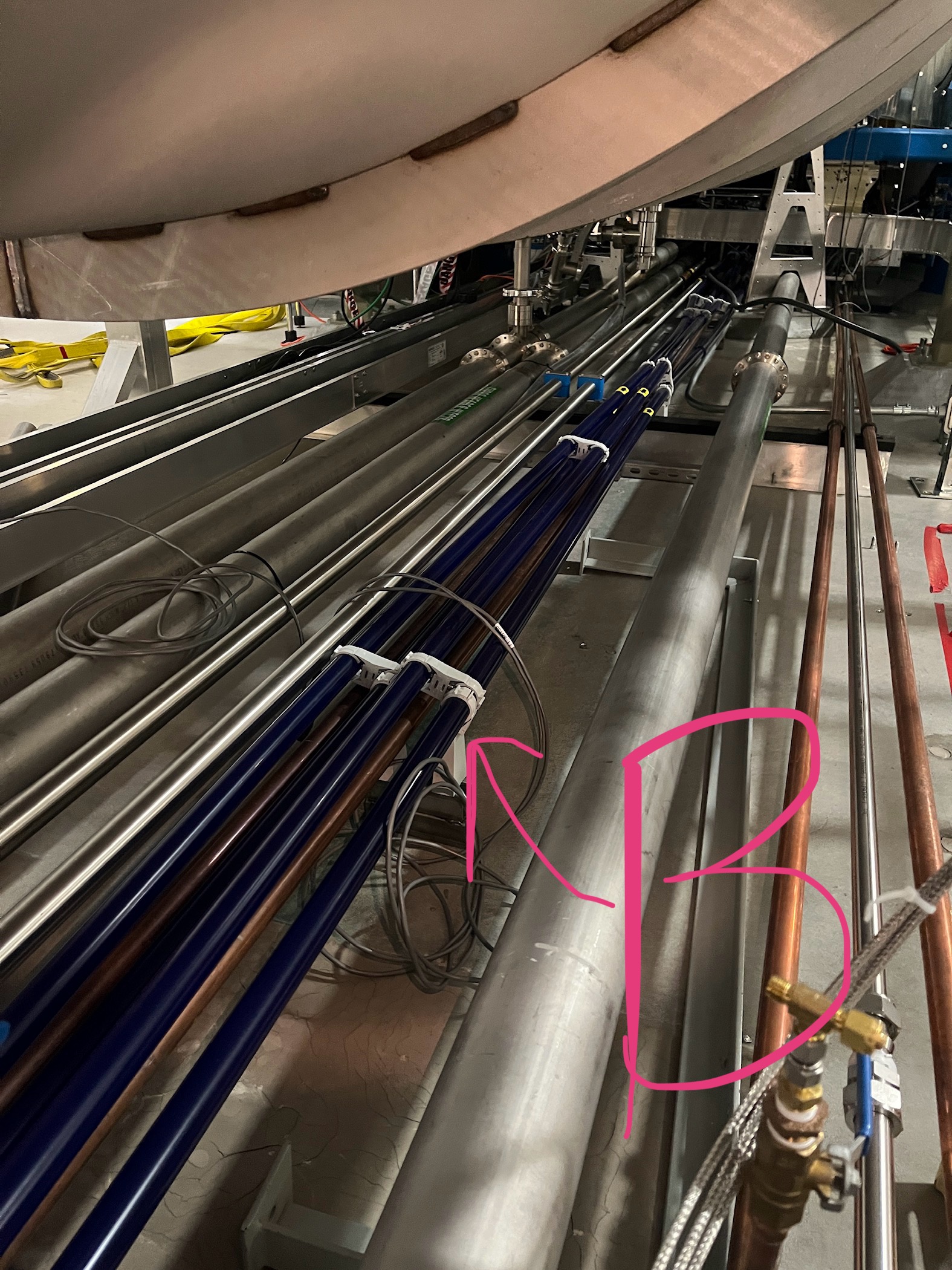

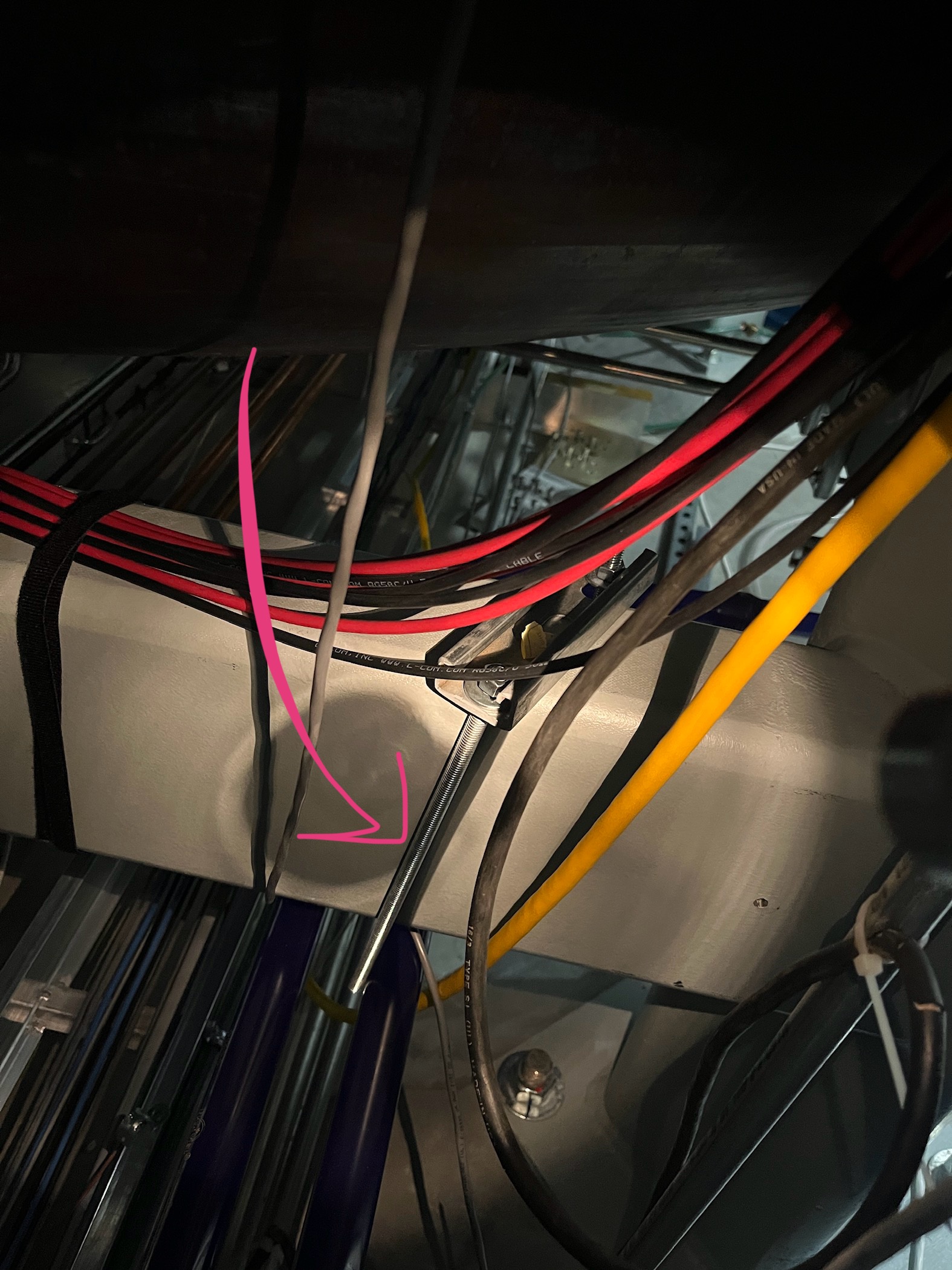

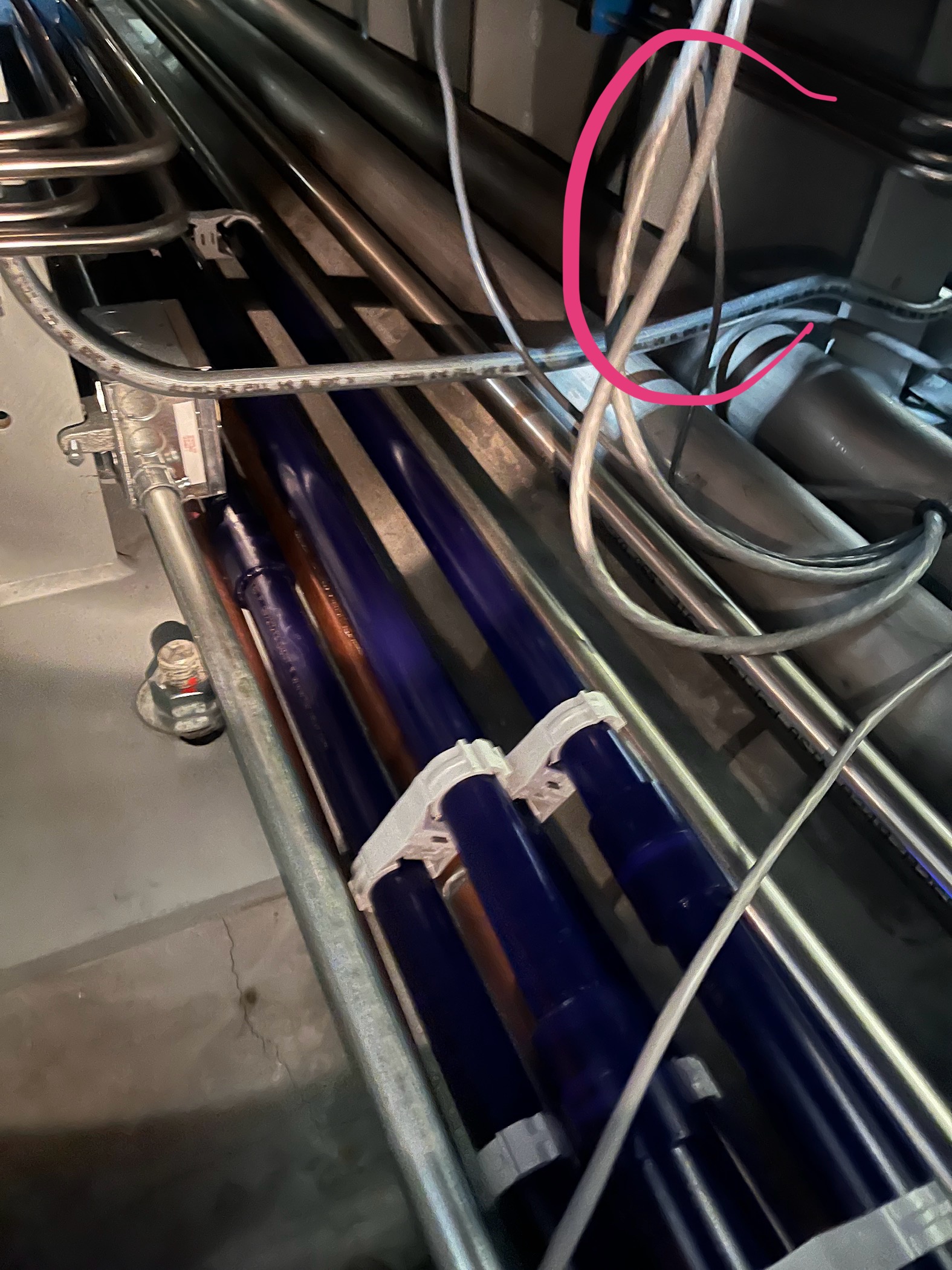

There 3 places where the pipes are not in their nominal 2x2 configuration: (A) before the drop down the the LVEA floor, (B) under the beamtube, (C) under HAM4. The pipes are also drooping in the longer stretch in the mechanical room. TJ is ordering more clic32 clamps that we plan to better support the pipes with. Also noticed a seemly unused metal bracket under BSC3, will check with SEI before removing.
New FRS prompted by FRS 30283, plan to complete bi-annually by the TCS team.
FAMIS 20015
PMC reflected power has come up and RefCav transmitted power has dropped again; we'll certainly do a PMC/RefCav alignment in the coming weeks to prep for commissioning work.
Wed Feb 14 10:09:58 2024 INFO: Fill completed in 9min 54secs
Gerardo confirmed a good fill curbside
HFD is doing a controlled burn of tumbleweeds along X ARM
The CDS conda environment has been updated.
If you run in to trouble with the new environment, you can switch back to the production environment with 'conda activate cds-py310-2023120401'
This environment includes two new programs from Gabriele: 'interactivefitting' and 'loopdesigner'.
It also includes a new release of diaggui and foton, version 4.0.3. This version has minor improvements and bug fixes.
foton now can suppress warnings for zeros in the right-hand plane. Pass -Z f as a command line argument or set the environment variable FOTON_WARN_RHP_ZEROS=false. The environment variable will also work with python-foton.
Difference cursors now work in diaggui plots.
For a full list of changes see https://git.ligo.org/cds/software/dtt/-/wikis/ChangeHistory
TITLE: 02/14 Day Shift: 16:00-00:00 UTC (08:00-16:00 PST), all times posted in UTC
STATE of H1: Planned Engineering
OUTGOING OPERATOR: None
CURRENT ENVIRONMENT:
SEI_ENV state: CALM
Wind: 11mph Gusts, 9mph 5min avg
Primary useism: 0.02 μm/s
Secondary useism: 0.34 μm/s
QUICK SUMMARY:
Fire Dept has 2 pickups and 2 Engines down X arm for Burning tumbleweed with Tyler.
Eric and Randy are already heading down to EY for Wind fence work.
HAM7 Door has been closed. and Vacuum team will likely be trying to start the prepareing for pump down today.
Today's activities: - HAM7 X+ X- doors have been closed. With the new X+ septum door, we had a hard time, as the O-ring didn't stay easily - The O-ring blanks have been installed back on the septum door - The Annulus volume of HAM7 - after closing the doors - is being pumped - Corner pumpdown status: we are at ~30 Torr - The Annulus Ion Pump of GV5 has been switched back on - EX pumpdown status: 4.33E-8 Torr

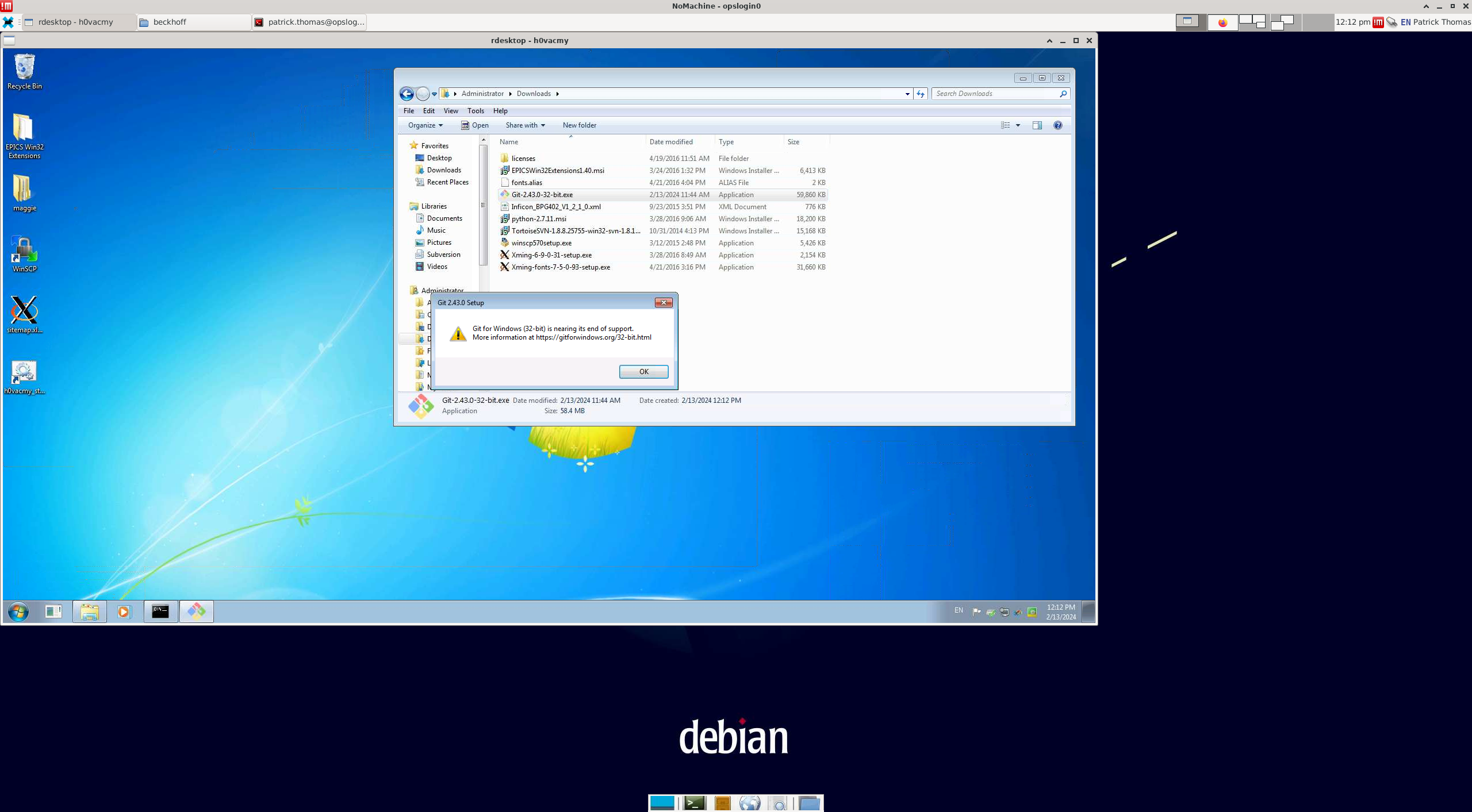

Closes WP 11686. I tried to use WinSCP to copy the Git for Windows installation file across from opslogin0, but it would not connect (something about the encryption protocol I think). I tried to update WinSCP, but the browser would not connect to the site (outdated Internet Explorer maybe?). I then recalled the Samba share I had set up, and copied the Git installer over from there. (For future reference, open the Windows file explorer and put \\10.20.0.118 in the location and use the username and password from the shared secrets page.) I first tried to install the 64 bit version, but was told by the installer that it was a 32 bit machine, so downloaded the 32 bit installer (Git-2.43.0-32-bit.exe) onto opslogin0 and copied it to the Samba share and then copied it from there onto the Windows machine. I received a warning when installing it that "Git for Windows (32-bit) is nearing its end of support. More information at https://gitforwindows.org/32-bit.html". I then cloned https://git.ligo.org/cds/ifo/vacuum/h0/medm.git onto the Desktop and ran the "/Source/create_medms.py" script in it. I changed the path in the sitemap.xlaunch shortcut to point to the cloned repo. The medm screens should now be up to date on all of the vacuum Beckhoff machines.
This reads like I just did this on one machine, but it was done for all except for h0vacly and h0vacmr, which already had Git installed from alog 65799. For those I just had to clone the new repo for the medm screens and update the sitemap.xlaunch.
LVEA is laser SAFE
Current ongoing activities
Jonathan, Dave:

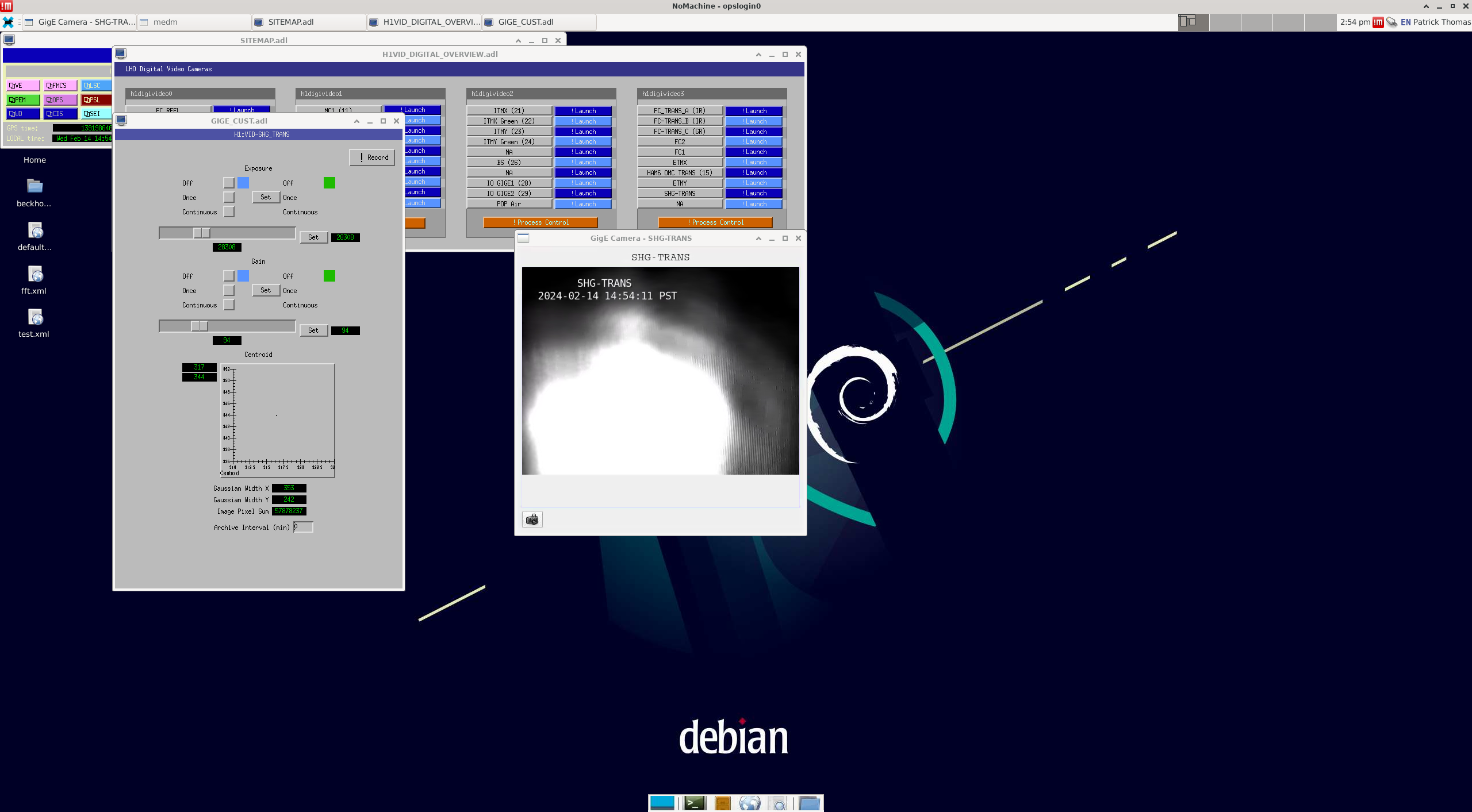

Following Jonathan's maintenance reboot of x1dtslogin, I restarted the dts_tunnel and dts_env services on cdsioc0 to reconnect with the DTS Gneiss environmental monitor.

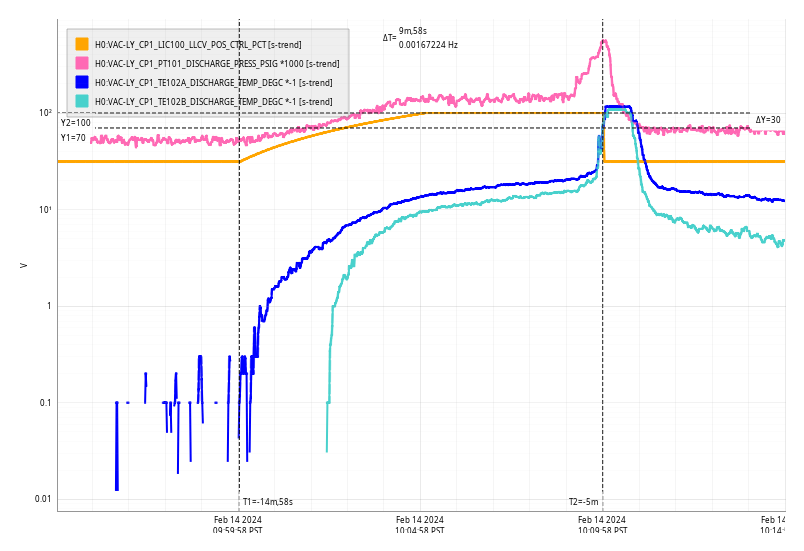

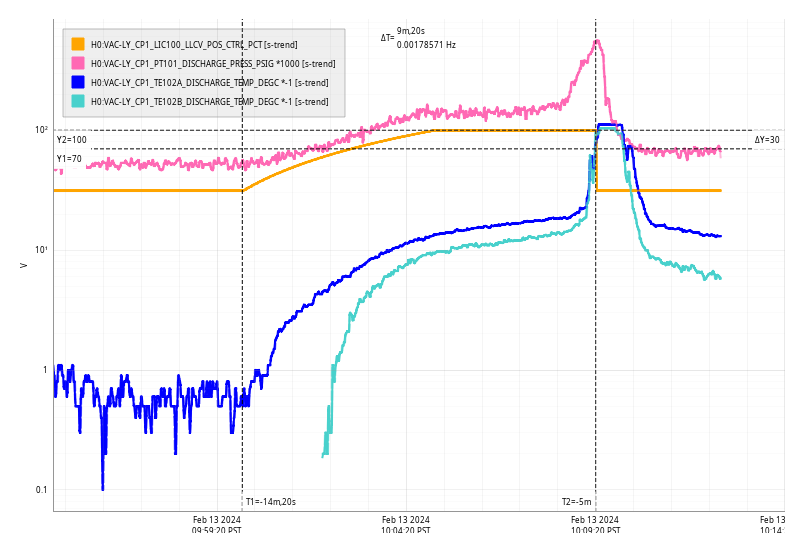

Tue Feb 13 10:09:20 2024 INFO: Fill completed in 9min 16secs
Gerardo confirmed a good fill curbside.
The dust monitor IOC was restarted this morning by Dave which can reset the alarm levels. Following document E1600132, I confirmed that the alarms levels are still set properly, The CS dm alarms, 5, 6 & 10 are set to the "Class-100" (major alarm at 100 counts for both 0.3u and 0.5u as opposed to their normal 10000 for 0.5u and 7000 for 0.3u) as defined in the document since these monitors are by vented open chambers. Once the chambers are closed back up I'll put the CS dm alarm thresholds back.
I've set the alarm levels for dust monitors 6 and 10 back to their nominal levels of 7000 counts minor and 10000 counts major for both 0.3u and 0.5u since HAM3 is closed and the cleanroom is off. Dust monitor 5 (HAM6) remains at the lower alarm level of 70 counts minor and 100 counts major.
DM5 is actually the DM by HAM3 and DM6 is by HAM5/6/7. So I set DM5 back to its higher levels since the doors back on and I lowered DM6s to CLASS 100 levels till the doors go back on later this week.
Sina, Elenna, Kevin, Evan
Similar to Anamaria's measurements at Livingston last year (LLO:58623), we drove PR3 sinusoidally in pitch and yaw at low frequency to try to ascertain the amount of beam spot motion coupling into the arms. The following times are all 2023–04–12 UTC:
At 0.34 Hz, the transfer functions from oplev to oplev are
The absolute values are indicated because the measured phases are neither clearly around 0° nor 180°. The coherences are above 0.85. (At 0.11 Hz, the coherences are somewhat lower so I omitted those values.)
Livingston also saw order-unity transfer functions like this: LLO:59846.
A series of finesse simulations (G2400278, G2400281) indicated that by itself, PR3 cannot drive arm cavity motion at this level since (in the absence of any angular feedback control) the arm cavity finesse suppresses PR3-induced spot motion by a factor of order 100. On the other hand, PR3 motion can appear in the reflection wavefront sensors with an optical strength similar to or even greater than cHard motion, meaning that if PR3 has not been carefully diagonalized out of the sensing matrix then its motion can easily be impressed onto the test masses with an order unity ratio.
The attachment shows coherences between PR3 oplev and test mass oplevs from the end of O4a. Ignoring the microseism region, there is coherence between PR3 pitch and EY pitch from 0.4 to 0.8 Hz. One might guess this coherence arises because of LVEA ground motion, but there is no coherence between the PR3 oplev and either the HAM1 Z L4C channel or the HAM2 Z ground motion.
