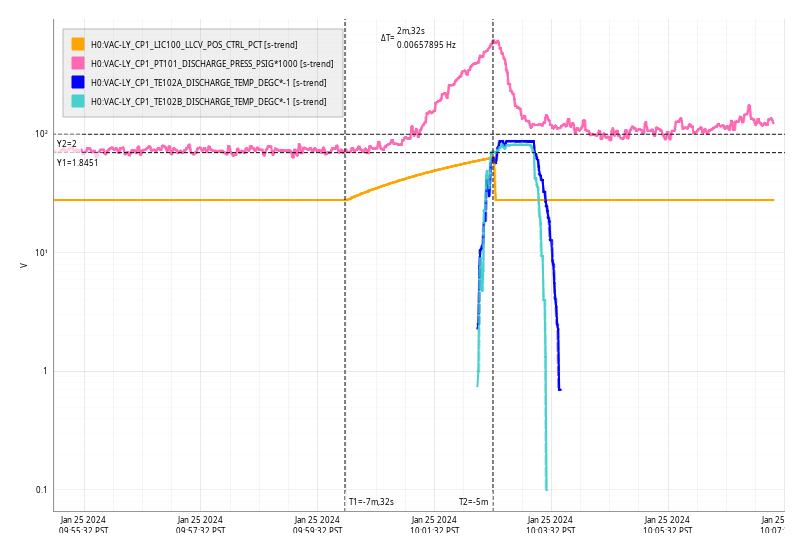

Fri Jul 26 08:08:56 2024 INFO: Fill completed in 8min 52secs
TITLE: 07/26 Day Shift: 1430-2330 UTC (0730-1630 PST), all times posted in UTC
STATE of H1: Corrective Maintenance
OUTGOING OPERATOR: Ibrahim
CURRENT ENVIRONMENT:
SEI_ENV state: MAINTENANCE
Wind: 0mph Gusts, 0mph 5min avg
Primary useism: 0.01 μm/s
Secondary useism: 0.07 μm/s
QUICK SUMMARY:
h1calinj model has a RED excitation state on the CDS Overview MEDM because the continuous hardware injection stopped running Thu 25jul2024 16:08:57 PDT.
I'm looking into why this excitation stopped at this time.

Dew point measurement taken this morning read at -43.4 oC. Measurement taken before removing HAM6 -X door. Some demand from HAM5, and HAM6 with soft covers on.
C. Compton, S. Dwyer, J. Oberling

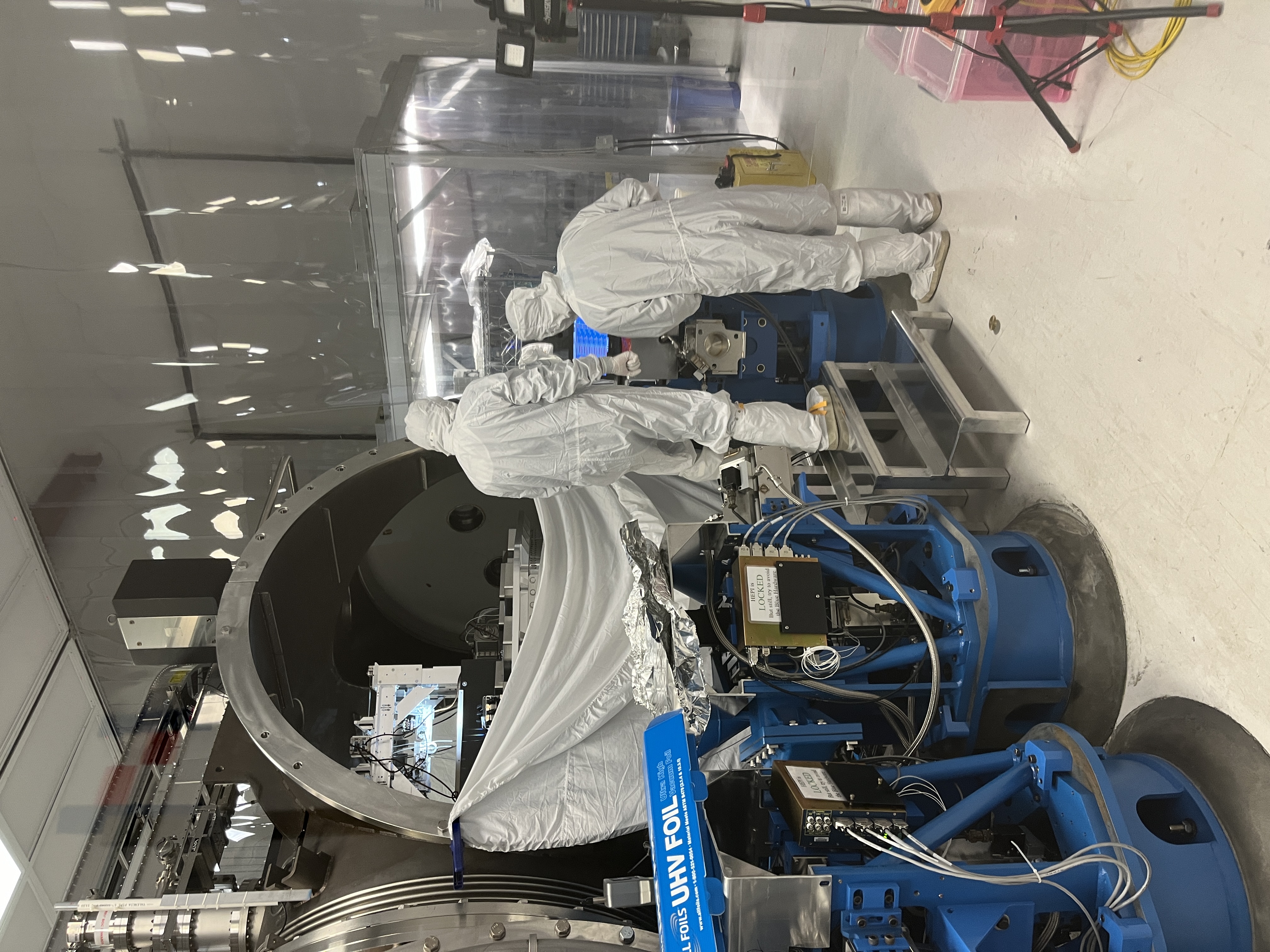

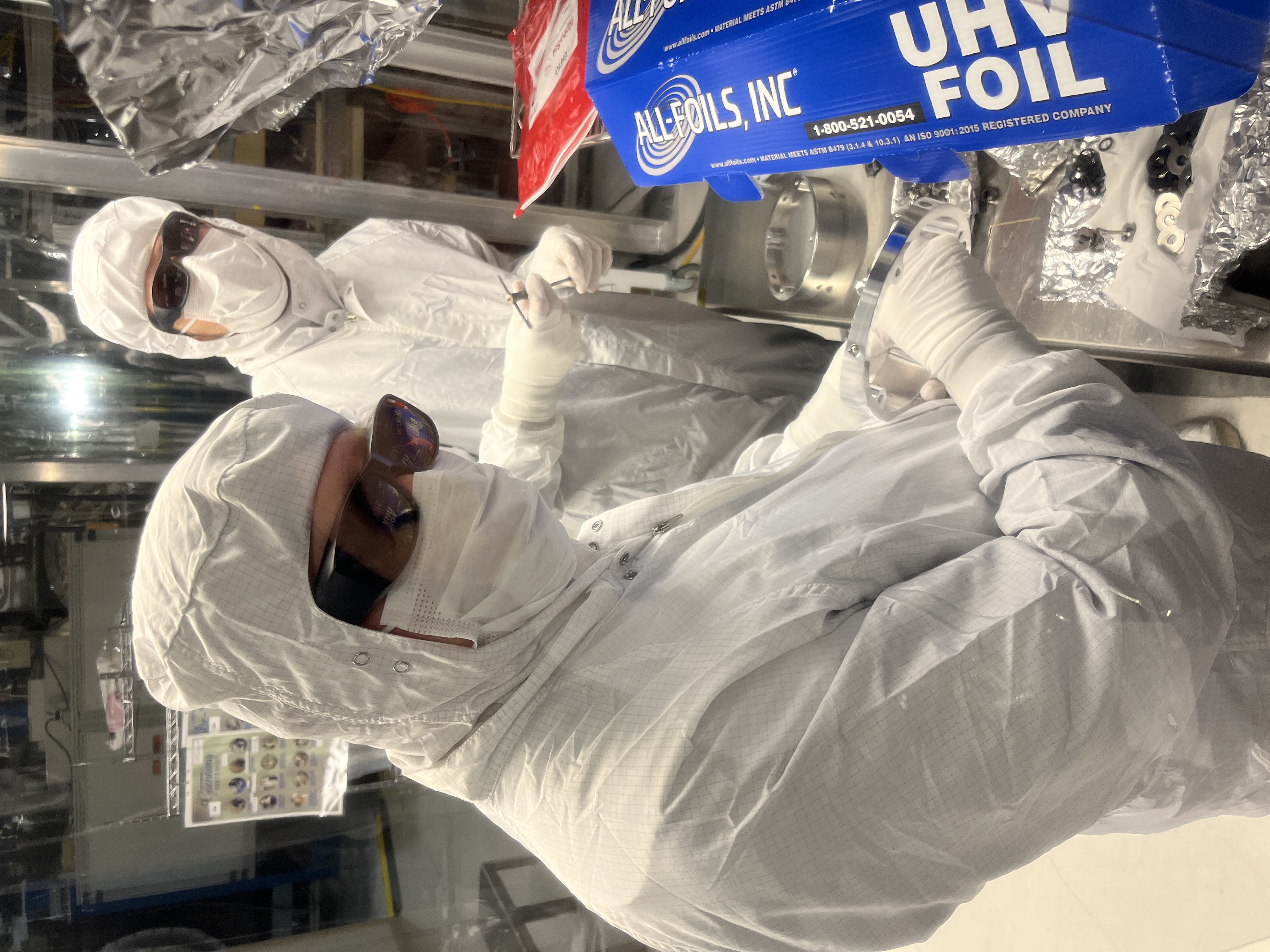

This afternoon we prepared the KTP wedge assembly for swap and realignment. Camilla had already mostly prepped a beam path for this using the beam reflected from the PBS cube in front of the Prometheus laser, but there was some oddness with the beam so Sheila and I moved one of the mirrors so we could use the beam transmitted by the PBS cube. There was still oddness with the beam when at low power (looked like it had a bit of a halo around it), but it went away at a slightly higher power (a couple mW vs just under 1 mW). Moving on, we aligned the beam along a row of holes and then installed the KTP wedge assembly (after Sheila wiped the area down several times with IPA wipes). We had removed the beam dump assembly before placing the KTP wedge in the beam path, and the bolts were very tight. It looked like the black coating on the assembly was also in the threaded bolt holes; this coating had been rubbed off by the bolts during assembly, and it looked like this was the cause of the difficulty in removing the beam dump assembly (there was coating visiblt deep in the threads but none on the outside where the bolt fully contacts the threads). A HWP was placed in the beam so we could adjust the power in the beams transmitted by the KTP wedge.
With the KTP wedge assembly in place we found the two transmitted beams and set irises in the near and far field, 2 irises for each beam. We also found the beam reflected from the front surface of the KTP wedge and placed an iris in this beam as well. I placed beam dumps to block the beams so there are not unblocked beams when the laser gets turned on. To preserve the cleanliness of the KTP wedge assembly I placed several layers of dry wipes over the assembly and then covered it with foil; I then wiped the area down again with IPA wipes. The KTP wedge assembly is now ready for the damaged KTP wedge to be swapped with a spare and realigned; Keita and Sheila plan on starting the swap and realignment tomorrow.
I've attached several pictures of the setup and they are, in order:
NOTE: There is now a Class A assembly in the Optics Lab. Please observe ALL posted contamination control signs when entering the Optics Lab, and DO NOT enter the far cleanroom (with the Prometheus laser on it) unless you are working on the KTP wedge assembly swap. This assembly is going back into the vacuum envelope, so we have to do our absolute best to preserve its cleanliness. Thank you.
Tagging for EPO.
Today's activities: - The purge air dew point was measured at the purge port: (9:15 am) -43.9 deg C, so it is consistently dropping in time. Some more specifics here: https://alog.ligo-wa.caltech.edu/aLOG/index.php?callRep=79306 - HAM6 -X door has been removed. The O-rings seem to be intact - The opportunity was taken for replacing the HAM6 RGA. It will be also re-wrapped with heat tapes, and after the chamber work ends, will be baked out. - Pressures: the arms' pressures slowly dropping (probably because of the weather is getting colder). The Y-manifold pressure is stabilized around 2-3E-8 Torr.
HAM6 RGA was swapped with a brand new Pfieffer PrismaPro RGA. We had not been able to connect to the old RGA since ~March 24, through the network nor locally using a laptop. The new unit has been installed and is currently prepped for bakeout once chamber work has finished.
TITLE: 07/25 Day Shift: 1430-2330 UTC (0730-1630 PST), all times posted in UTC
STATE of H1: Corrective Maintenance
INCOMING OPERATOR: None
SHIFT SUMMARY: KTP has been removed from the OFI and is in the Optics Lab(79315), where it will be removed and replaced.
LOG:
| Start Time | System | Name | Location | Lazer_Haz | Task | Time End |
|---|---|---|---|---|---|---|
| 14:00 | FAC | Chris, Eric | LVEA | n | Starting door removal | 14:44 |
| 14:52 | FAC | Karen | LVEA | n | Tech clean | 15:32 |
| 14:56 | FAC | Kim | LVEA | n | Tech clean | 15:22 |
| 15:16 | OFI | Camilla | LVEA | n | Move AUX laser out of the way | 16:28 |
| 15:18 | FAC | Gerardo, Jordan, Tyler, Chris, Eric, Janos | LVEA | n | Taking HAM6 door off (Eric, Chris, Tyler out 16:10)(Janos out 16:16) | 16:28 |
| 15:25 | FAC | Richard | LVEA | n | Watching door removal | 15:33 |
| 15:28 | EE | Fil | MY | n | Picking up parts | 15:52 |
| 16:03 | FAC | Kim | H2 | n | Tech clean | 16:17 |
| 16:27 | OFI | Camilla, Jason | LVEA | n | OFI work | 18:51 |
| 16:49 | OFI | Tony | LVEA | n | Taking tiny magnet in big bag out to OFI team | 17:03 |
| 17:05 | FAC | Eric, Chris | EX | n | Fan swap | 18:56 |
| 17:08 | FAC | Richard | LVEA | n | Watching OFI work and trying not to laugh | 18:35 |
| 17:29 | OFI | Keita | OpticsLab | y(local) | Prep for KTP | 20:02 |
| 17:32 | OFI | Sheila | LVEA | n | Helping with OFI and looking for cube | 18:56 |
| 17:33 | PEM | Robert, Carlos, Millie | along YARM | n | PEM work for CE | 19:29 |
| 17:35 | VAC | Gerardo, Jordan | LVEA | n | Checking RGA for leaks | 18:19 |
| 18:49 | FAC | Richard | LVEA | n | Checkingn out work | 19:32 |
| 20:24 | VAC | Janos, Jordan | LVEA | n | Looking for parts | 21:54 |
| 21:15 | OFI | Sheila | OpticsLab | y(local) | Working on KTP optic | 22:54 |
| 21:25 | OFI | Camilla | OpticsLab | y(local) | Working on KTP optic | 22:47 |
| 21:29 | OFI | Jason | OpticsLab | y(local) | Working on KTP swap | ongoing? |
C. Compton, S. Dwyer, J. Oberling
This morning we removed the KTP wedge assembly (D2000038) from the OFI and moved it into the OSB Optics Lab.
We began by trying the "transport shims" that are supposed to help secure the OFI. Unfortunately, these did not work. The slot in the shims was not wide enough to fit around the OFI Earthquake Stop Posts we were supposed to fit them around, and the shims were too skinny (the posts bottomed out before contacting the shims). So we had to pivot to Plan B, which was to use dog clamps instead. This mostly worked, but the OFI still moved around enough that we decided one of us would try to support the OFI while the other turned bolts. Camilla has some pictures of this and will post as a comment to this alog. Even still, we managed to almost immediately dislodge one of the OSEM magnets (the one near the lone +X/+Y OSEM) as soon as we started trying to remove the KTP wedge assembly (the magnet is still stuck to the flag on the OFI, will need to have its polarity checked and be put back in place).
We first placed a teflon sheet in between the KTP wedge and the quartz rotator assembly. Using non-magnetic tools (a titanium hex key that had been bent so it would fit in the space between the KTP and FS wedges, and a beryllium copper one that had been cut short) we attempted to remove the beam dump assembly from the KTP wedge assembly. Camilla held the OFI and I tried to loosen the bolts holding the beam dump on the KTP wedge. I say "tried" because the bolts are frozen in place. We were unable to get them to move, at all. Pivoting again, we found that the beryllium copper hex key was short enough to fit under the beam dump assembly, so we began loosening the two bolts on the +Y side of the KTP wedge assembly; Camilla had to crawl in the -X door to access the -X bolt while I held the OFI. This worked until the -X bolt was loose enough that we could no longer fit the hex key under the beam dump assembly. At this point Sheila used a T-shaped titanium hex key to loosen the -Y bolt on the KTP wedge (the bolt directly under the quartz rotator) while I held the OFI, and then I loosened the +X bolt. With these 2 bolts loose we were able to lift the KTP wedge assembly enough that Camilla could fit the hex key under the beam dump assembly again. In this way were able to slowly work the -X bolt free. With all bolts free I carefully removed the KTP wedge assembly while Sheila held the OFI. We Ooohh'd and Ahhhh'd at the craters in the KTP wedge for a bit and took some photos (see attached), and Camilla and Sheila grabbed some more pictures of the back side of the FS wedge (more access, and therefore better viewing, with the KTP assembly out of the way). We also removed the teflon sheet from in front of the quartz rotator.
We ensured all of the non-magnetic tools were separate from other tools in the cleanroom, safely wrapped up the tools we would need as well as the KTP wedge assembly, and moved everything to the optics lab to start prepping for swapping and realigning the KTP wedge assembly (the beam dump assembly will have to be removed in the Optics Lab). I've attached a few closeup pictures of the KTP; 2 are viewing the front surface and one is viewing the back surface (better view of the coating damage around the craters). Camilla has several other pictures that she'll attach as a comment to this alog.
Note on the D1300098 OFI Transport shims, looking at 3.1.2 and 4.2.1 of E1300056-v4, it appears we were trying to use them incorrectly and should replace the Earthquake Stop Posts with 1/4-20 bolts. We could try this next week but it would involve removing another shroud panel to get clearance...

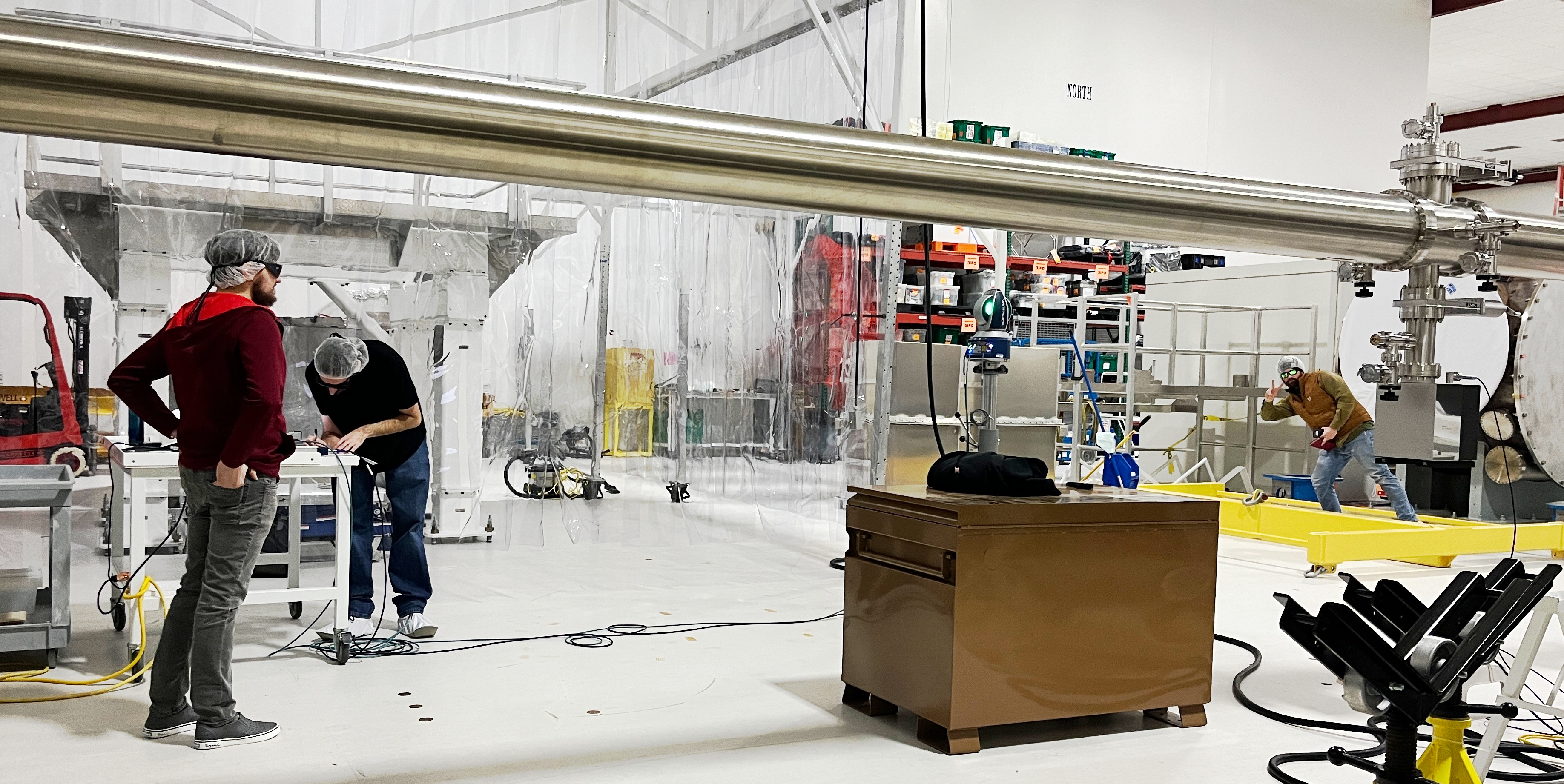

The first three photos attached show the OFI with the KTP removed, and looking through the FS towards the magnets. Third one shows splatter on FS.
Forth/fifth photos show the dog clamps we used to help support the sled and the osem magnet that got turned over: photo.
Tagging for EPO.
PCAL has had a Paper Log of all the measurements taken from Spring2023 to Summer2024.
Since Jun24, We have switched over to a google Doc PCAL-Lab-Log, a new log will likely be made by the scripts in the near future.
Closes FAMIS#27794, last checked 79168
TCSX: At 30.3. No water added.
TCSY: At 10.5. No water added.
No leak in water cup
Laser Status:
NPRO output power is 1.822W (nominal ~2W)
AMP1 output power is 65.16W (nominal ~70W)
AMP2 output power is 138.0W (nominal 135-140W)
NPRO watchdog is GREEN
AMP1 watchdog is GREEN
AMP2 watchdog is GREEN
PDWD watchdog is GREEN
PMC:
It has been locked 15 days, 21 hr 10 minutes
Reflected power = 18.79W
Transmitted power = 108.0W
PowerSum = 126.8W
FSS:
It has been locked for 7 days 17 hr and 43 min
TPD[V] = 0.7268V
ISS:
The diffracted power is around 2.4%
Last saturation event was 8 days 18 hours and 55 minutes ago
Possible Issues:
PMC reflected power is high
Thu Jul 25 08:08:24 2024 INFO: Fill completed in 8min 20secs
Jordan confirmed a good fill curbside.
TITLE: 07/25 Day Shift: 1430-2330 UTC (0730-1630 PST), all times posted in UTC
STATE of H1: Corrective Maintenance
OUTGOING OPERATOR: None
CURRENT ENVIRONMENT:
SEI_ENV state: MAINTENANCE
Wind: 4mph Gusts, 2mph 5min avg
Primary useism: 0.01 μm/s
Secondary useism: 0.06 μm/s
QUICK SUMMARY: We went to laser safe yesterday afternoon and are ready for today's work
Today's plan:
Jason, Jenne, Camilla, Keita, Francisco, Naoki, Sheila. (Please see Francisco's alog for more details 79300)
Today we got the alignment laser set up and the sqz beam checks done in a way that we think is good enough to move forward with removal of the KTP tomorow. There are more detailed notes in other alog drafts, and photos coming.
We found this morning that the beams were not where they were left last night on the OM1 + retro reflection irises. We decided that this was likely due to the wobbly mount with sticking knobs that the steering mirror was in, this would change the alignment from being touched, and sometimes turning the knob did not adjust the alignment because the knob wasn't engaged. We decided to swap this mount out which took some time, but after that things went smoothly, and with about 3 iterations we were able to center the beam on SR2. We then did a quick check of the squeezer beam, which goes through the OFI and returns to OM1. We got some cool photos of showing a hole in the middle of the beam; we intentionally set it's alignment to go through the most recent crater.
We are ready to go to laser safe, and the door crew plans to take HAM6 door off in the morning. After that we will remove the KTP assembly.
Camilla, Jason, Jenne, Keita, Sheila, Francisco, Naoki
Summary: We are done for AUX laser alignment and power measurement of AUX laser. SQZ beam got to OM1, but we did not do power measurement due to noisy seed dither lock. The following are a mixture of notes between Camilla, Francisco, and Naoki regarding the changes done today:
Aiming for 2 1/4" above EQ stop as 4" between vertical stops and the center of SR2 optic is 5.5mm above center line of EQ stops.
At start of the day, someting had drifted (mainly pitch), re-centered AUX laser on irises.
*Iterating moving auxiliary laser mirror and beamspiltter to center in om1 and retroreflection irises.*
Checking position at SR2:
Swapped the AUX laser steeing mirror to a better optic mount and not woberly perdistal, we are blaming this for our drift.
Jenne also adjusted SRM sliders to yesterdays values.
*Iterating moving auxiliary laser mirror and beamspiltter to center in om1 and retroreflection irises.*
Checking position at SR2:
Moved SRM osems from (175, 140) to (50,190). In pitch moved -125urad from 175 to 50 on osems. In yaw moved +50urad. this was 140 to 190 on osems
Aiming to center the beam on SR2
*Iterating moving auxiliary moving mirror to center in om1 and retroreflection irises.*
Checking position at SR2:
EQ stops are 2 1/2 in away from each other; center is 1 1/4 in from horizontal EQ stop
Will do 100 microrad in -YAW, then check retro in OM1. -100urad in yaw is 190 to 90 on osems
*Iterating moving auxiliary moving mirror to center in om1 and retroreflection irises.*
Checking positions at SR2:
In yaw going +300 urad. This is 90 to 390 on osems.
*Iterating moving auxiliary moving mirror to center in om1 and retroreflection irises.*
Checking positions at SR2:
*LUNCH BREAK*
Sheila back to SR2;
earlier today SRM P moved from 179 to 50. 1 1/4 inch move on SR2
Moved 1/4 inch backward. moved SRM P from 50 to 76
Sheila is happy with SR2 centering.
Jason is setting iris on OM1. Beam on OM1 ugly? due to crater on OFI?
ASC_AS_C P -0.6 Y -0.6
open GV for HAM7. send SQZ beam. seed dither lock is very noisy.
SQZ beam is close to AUX laser?
AUX power measurement
First three attached photos are of the aux laser steering mirror we swapped in, original mirror in 79253.
Fourth photo is the iris we places between the aux laser beamsplitter and SRM. Once we were finished with the alignment Jenne and Sheila recentered this iris on the beam.
The power measurements recorded are with the AUX laser as we had trouble dither locking the SQZ seed beam. More details:
Sixth image is the SQZ beam and aux laser beam (smaller) after SRM. They are misaligned in yaw.
Seventh image is te SQZ beam and aux laser beam (below) before OM1. They are misaligned in pitch.
Tagging for EPO.
Dew point measurement taken this morning by Jordan, read at -43.9 oC. Some demand by HAM5/6, small crew at work.
End of the day dew point measurement, -43.6 oC. No demand, all soft covers closed for HAM5/6 and HAM7 is under small pressure and isolated.
Note regarding HAM7: before the 10" gate valve is open, chamber needs a blow down, see a vacuum representative.
TITLE: 07/24 Day Shift: 1430-2330 UTC (0730-1630 PST), all times posted in UTC
STATE of H1: Corrective Maintenance
INCOMING OPERATOR: None
SHIFT SUMMARY: The OFI team was able to get the AUX laser aligned and verified that the SQZ beam can get to OM1. Tomorrow morning first thing we will be transitioning the LVEA to laser safe and continuing the OFI work by taking the KTP out and taking the HAM6 -X door off.
LOG:
- Continuing work on aligning AUX laser
- Aligning sqz beam
- Getting ready to transition to laser safe
| Start Time | System | Name | Location | Lazer_Haz | Task | Time End |
|---|---|---|---|---|---|---|
| 15:11 | FAC | Kim, Karen | LVEA | YES | Tech clean, (Karen out at 1600) | 16:23 |
| 15:20 | VAC | Jordan | LVEA | YES | Checking purge air | 15:31 |
| 15:41 | OFI | Camilla, Jason, Sheila | HAM5 | Y | AUX laser work | 19:41 |
| 16:10 | OFI | Keita | LVEA | YES | OFI work | 19:41 |
| 16:11 | FAC | Richard | LVEA | YES | Checking in on OFI work | 17:34 |
| 16:38 | FAC | Karen | WoodShop | n | Tech clean | 17:27 |
| 17:25 | FAC | Kim | MX | n | Tech clean | 18:27 |
| 18:09 | FAC | Karen | EY | n | Tech clean | 18:58 |
| 18:28 | OFI | Francisco | LVEA | YES | Helping with OFI | 19:41 |
| 19:12 | ISI | Jim | EY | n | Recovering EY from HEPI/ISI trip | 19:46 |
| 19:15 | Richard | LVEA | YES | Checking in on OFI peeps | 19:41 | |
| 20:41 | OFI | Camilla | LVEA | YES | More AUX aligning for OFI | 23:30 |
| 20:50 | OFI | Jenne, Naoki, Sheila, Jason | LVEA | YES | Continue AUX alignment work for OFI (Sheila, Jenne out 22:55)(Naoki our 23:08)(Jason out 23:27) | 23:27 |
| 21:51 | VAC | Gerardo | LVEA | YES | Purge air for HAM7 | 22:02 |
| 21:29 | VAC | Janos | EY | n | Purge air photos | 21:48 |
| 21:49 | FAC | Tyler | LVEA | YES | Prepping for HAM6 door removal | 21:52 |
| 22:10 | OFI | Keita | LVEA | YES | OFI help | 22:55 |
| 23:08 | EE | Marc, Fil | MY | n | Looking for parts | ongoing |
| 23:09 | FAC | Tyler | LVEA | YES | More prep work for HAM6 door | 23:13 |
