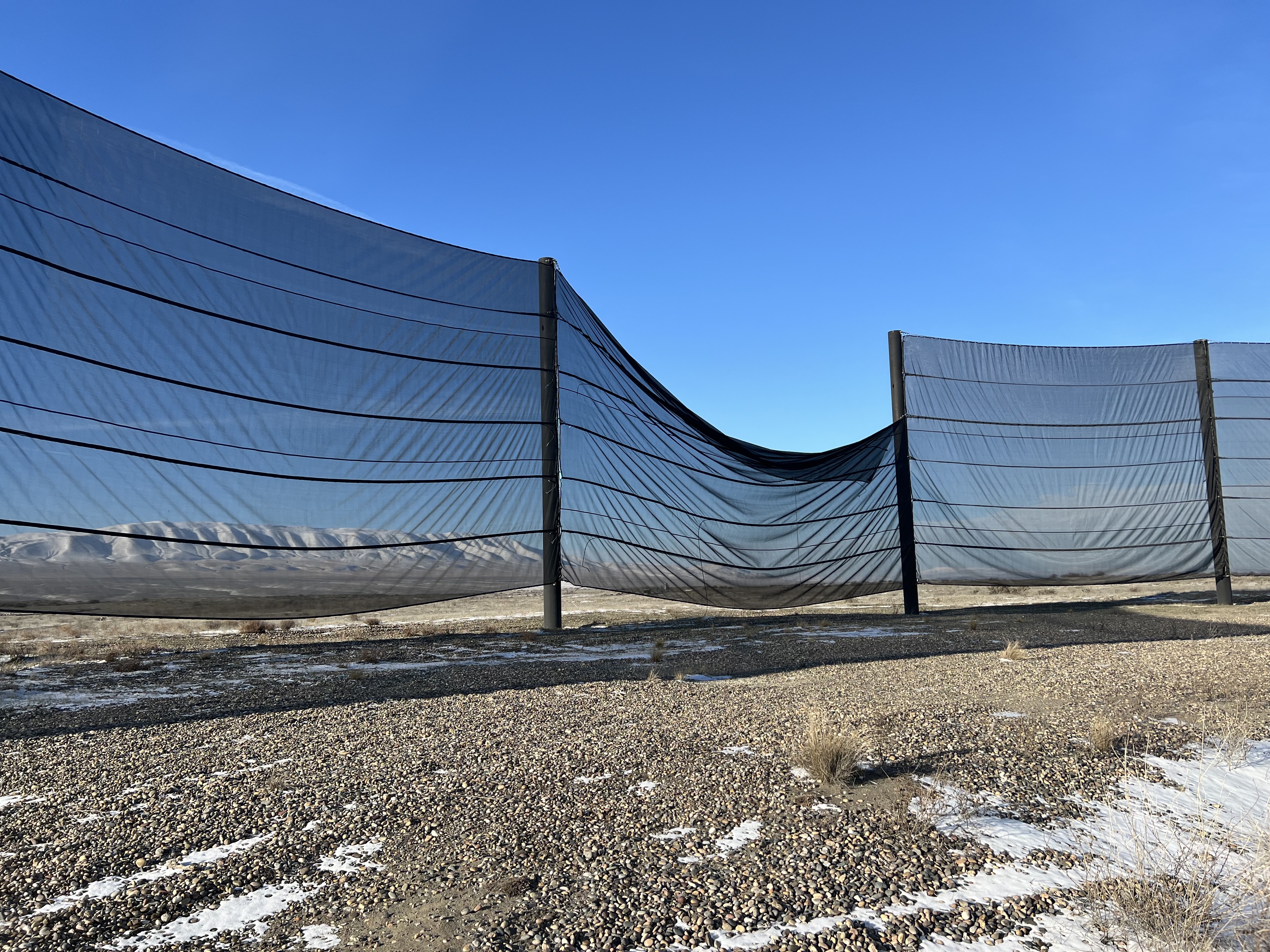

For the record, late alog - a couple weeks ago the EY wind fence was found to be damaged, again from early JAN severe winds (50+mph gusts for a few days).
Plans are in place to repair it with an improved round of reinforcement. A second snorkel lift is being delivered to aid in the repair scheduled for ~next week. FRS ticket filed.
tagging EPO for our EY wind fence

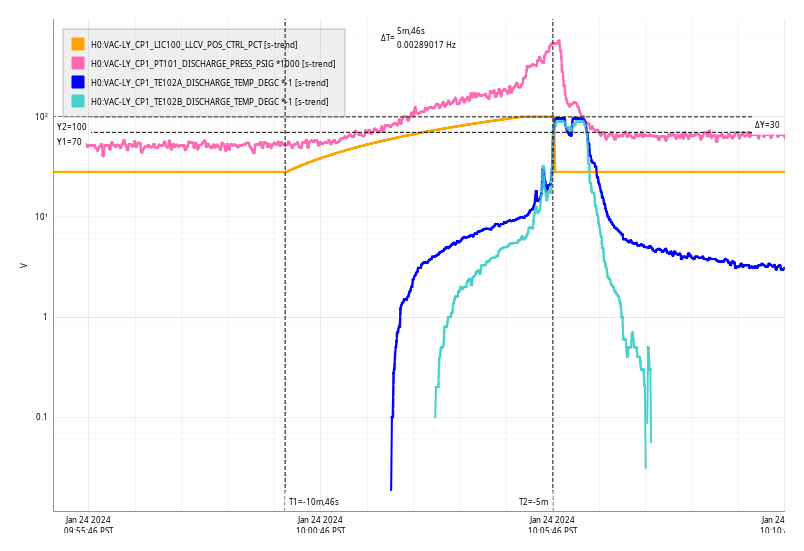

Wed Jan 24 10:05:46 2024 INFO: Fill completed in 5min 43secs
Naoki Vicky Daniel
We physically placed the PMC, the RF photodetector, and a bunch of steering mirrors into the empty space on SQZT0. Everything seems to fit as planned. No beams yet!
We also installed the Thorlabs PDA100A that serves as the PMC_TRANS monitor. It is installed along the seed path. There is a 50:50 splitter that reduces the seed power by 2. We installed a one-side AR coated wedge in the path of the beam dump to get about 19mW of light that we steered onto the PDA100A.
The slow controls system was upgraded to add new channels associated with the PMC and update some channels names. There is no longer a FIBR_REJECTED PD, instead we added a FIBR_INPUT PD that monitors the fiber power from squeezer laser in the beat note box.We no longer have a monitor for light in the wrong polarization at the laser locking beat note. Instead, we have to use the beat note strength to optmize the input polarization.

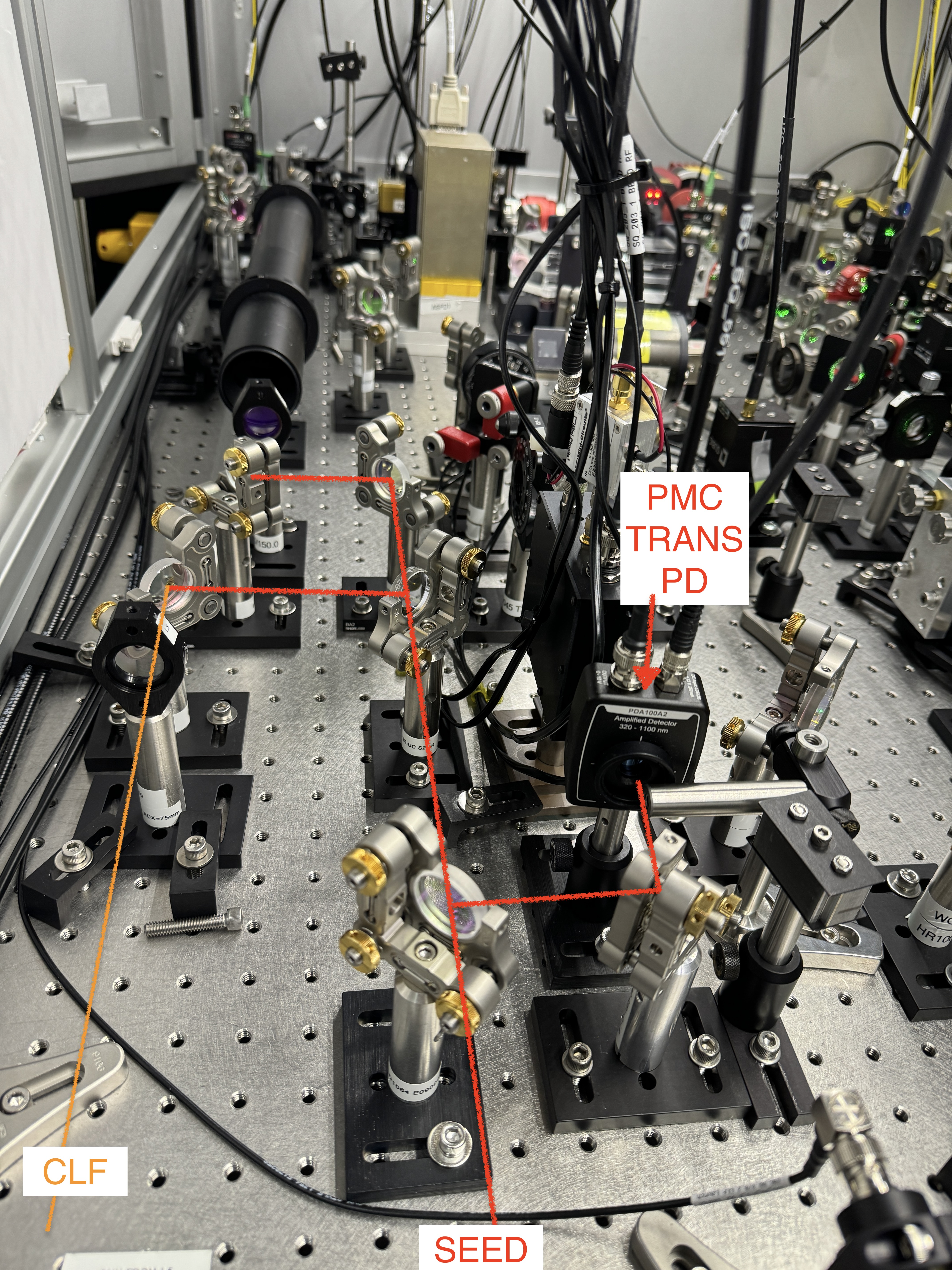

Some photos here. Here is the PMC TRANS PD path and aligment, including the beam dumps. Here's a photo of PMC + RFPD fitting into the table, to-be aligned afterwards. The SHG beam path clears the back of the PMC, so that's good.
We also installed a longpass filter onto the SEED_LAUNCH_PD (FEL0850, cuts-on above 850nm), so we can now open the SQZT0 table lights without changing the measured seed launch power.
Updated medm
Per WP11624 replaced the squeezer slow controls Kepco power supply due to issues had with it in ALOG75331.
Old Kepco Serial Number = S1201988
New Kepco Serial Number = S1201903
Temperature and airflow measurements in new supply are similar to the old supply. I suspect the thermal cutoff on the old supply is not functioning correctly.
[Measurements attached]
FAMIS LINK: 25975
BSC CPS: Received following from CPS script terminal output:
NOTE: If one was to follow the above channel as an example, it would seem several other BSCs had CPS' with spectra similarly high by eye:
HAM CPS: Looks good.
TITLE: 01/24 Day Shift: 16:00-00:00 UTC (08:00-16:00 PST), all times posted in UTC
STATE of H1: Planned Engineering
OUTGOING OPERATOR: None
CURRENT ENVIRONMENT:
SEI_ENV state: CALM
Wind: 4mph Gusts, 2mph 5min avg
Primary useism: 0.02 μm/s
Secondary useism: 0.27 μm/s
QUICK SUMMARY:
Rick and I went to EndY to do the PCAL Tx module maintanence today.
We followed Mostly followed the procedure outlined in DCC doc T1600436-v11 which was printed out and attached to the ALOG.
I have also updated the PCALTxMaintenanceLogBook spreadsheet with the latest information from today's activity. This is information is now in the DCC with an updated version number.

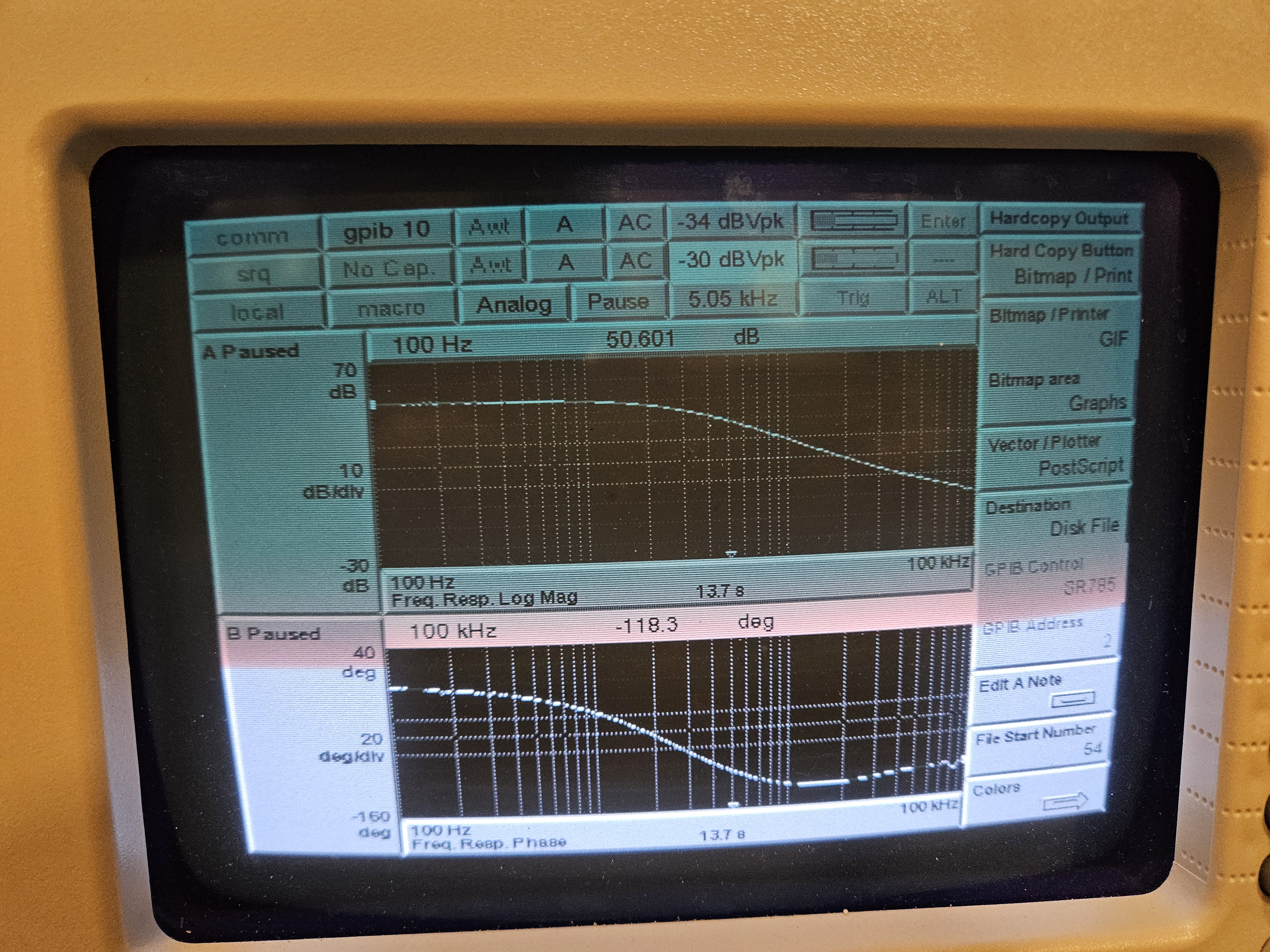

Attached a picture of the OLTF taken with the SR785 .
And a beam spot with both beams after we were finished cleaning and measuring.
[Rahul Betsy Keita Ali Koji]
The extraction of the old OMC (Unit #3) and installation of the new OMC (Unit #1) went exceptionally well.
= OMC Extraction =
Tuesday morning, we resumed HAM6 work from the OMC extraction.
Rahul and Koji went into the chamber. Rahul positioned close to HAM5, and Koji was on the other side.
They followed the extraction procedure (E1600164) after some rehearsals.
During the OMC extraction, assistance from two others was very effective in supporting wires from both HAM6 openings, preventing the wires from touching the OMC. (The procedure to be updated)
The extracted OMC was placed in the fixture on the ISI and moved back to the work table for further action.
= Balance Mass Migration =
Balancing masses were transferred from the previous OMC to the new one (Attachment 1). At the same time, a Viton ring and a 10g mass were added to each corner for the body mode damping (See T1700471).
The mass distribution differed from what Koji had figured out from the past unclear photos. But the masses could be fixed to the OMC using various 1/4-20 screws that were prepared for this.
Only light torque was applied to the fixing screws to avoid delamination/fracture of the mounting brackets below the mass mount.
= Final OMC cleaning =
All the optical surfaces were cleaned by FirstContact except for a couple of surfaces where the access was quite limited. (Attachment 2)
We let the FC paint dry during lunch and then resumed peeling them off, combined with discharging with Top Gun.
The surfaces were checked with a flashlight to find any residual.
A FC residual was located not on the optical surface but on the corner of a tombstone prism. It was cleaned with additional FC paint.
In parallel with the cleaning work, Ali and Keita worked on the review of DCPD-related cable shielding in HAM6.
= OMC Installation =
The reverse process of the extraction has been performed.
When inserting the clamps into the clamp hooks, sometimes incomplete mating happens due to friction between the copper cone and the frosted glass cup.
This can be fixed by pushing the clamp into the slit by a small flat-head driver, while the tension on the wire was released by lifting that side of the OMC.
= EQ stop release =
Reverse process of the OMCS mass clamping.
This made the OMC free. Rahul quickly checked the transfer functions of the OMCS as well as the damping control.
We decided to stop here. (Attachment 3)
Next Steps:
The attached PDF shows the previous and current balance mass configurations.
The highest mass has the height of 2 7/8" from the mating plane of the fixture, while the fixture has 3" clearance,
So we still could close the lid with the gap of 1/8".
Wonderful, CONGRATS!!!
Koji, Keita, and Rahul in HAM6.
Tagging EPO for photos
[Julian, Naoki, Camilla, Sheila, Vicky]
Summary to get SQZ alignment beam: Launched 76mW into seed fiber, ~25 mW incident on opo cavity, ~0.85 mW transmitted through opo cavity. Had to find opo transmission past the VIP, for this we used green SK path as a reference. This ~0.85 mW opo transmission was bright on an IR card at the HAM5 gate valve, and enough to iris the SQZ beam in HAM7 and HAM6 (for OMC work 75512). DC 3/4 centering loops engaged easily, then OMC A/B QPD's saw the sqz beam.
----------- Notes from today ------------------------------------------
Launched power into SEED fiber (SQZT0): 76 mW
OPO IR REFL (CLF_TRIG_REFL_DC_POWERMON @ SQZT7): 24.8mW (when opo is dither-locked).
Fiber rejected power PD in HAM7 (CLF_REFL_REJ) is 5.3 mW.
--> Seed fiber coupling: ~34% of the seed fiber launched power was incident on the opo cavity.
--> 40% coupling through fiber, ~6% mispolarized and rejected after fiber. This is similar to recent fiber alignment 75344, even after more recent on-table work 75486.
We had to find the OPO IR transmitted beam after the VIP. Nothing at first despite restoring suspensions 75502. Notes to self on what worked to find the SQZ beam post-vent:
OPO IR TRANS (OPO_IR_PD_DC_POWERMON @ SQZT7): 0.85 mW -- Just before opening the HAM7/5 gate valves. Opened the beam diverter, SQZ beam was bright on an IR card held at the HAM5 gate valve.
After opening gate valve, immediately saw the beam on AS A/B/C QPDs.
ASC-AS_A/B_DC_SUM_OUTPUT ~ 60. ASC-AS_C_NSUM_OUT16 ~ 0.65-0.67.
HAM6 crew irising SQZ beam, 75512.
HAM7 crew irising SQZ beam. Julian has some photos of HAM6 and HAM7 irses. Sheila -- looks like there is some clipping on the VIP (we have not totally optimized FC_REFL path slider alignments post-vent, just found the beam). Revisit this FC REFL alignment later.
Engaged DC 3/4 centering. It just worked. Control signals near 0.
We see the beam on the OMC QPD's, power is consistent with ASC-AS_C power, around 300-400e-6 on each OMC QPD A/B. Power goes away when SQZ beam diverter is closed. See omc powers screenshot with as_wfs powers.
TO-DO SQZ work later:
tagging for EPO
Accepted ZM1,2,3,4,5,6, FC1,2 OPTICALIGN sliders in sdf. Attached is the photo so we'll know where to bring them back to after pumpdown.
ZM4,5,6 are not monitored - should remember why that is....
Camilla, Naoki, Vicky
Next day 1/23, we tried to help check OMC alignment, but after turning the SQZ laser back on, we didn't find the beam past the VIP at first.
To re-find the sqz beam, we had to move FC1 quite a bit (pitch slider by 100 counts, yaw slider by 65 counts). See FC1 SDF's of today's move, compared to what Camilla just accepted in SDF after we first found the beam yesterday 75517.
Naoki checked FC1 and ZM1-2-3-4-5-6 SUS, and did not see any anomolous movements of the optics.
We left FC1 with an alignment that maximizes signal on both HAM7 FC WFS (RLF QPD's). Both QPD's are now saturated with 75mW into the fiber. With 5mW into the fiber to un-saturate, both QPD's are close-ish to centered.
Hopefully this is enough to use AS A/B WFS centering tomorrow. Today when we tried it, DC3 worked, but DC4 railed as the beam wasn't hitting AS_B well.
Sheila, Camilla, Vicky
We re-found the SQZ beam in HAM6 this morning after opening the ham5 gate valve. Steps taken this morning 1/24, after yesterday using FC1 to align onto the HAM7 FC WFS QPD's:
For convenience while vented, I made the following guardian changes so far:
All guardian edits (+sqz angle servo flag in sqzparams.py) commited to svn revision 27088.
Attached Julian's photos of the iris locations on HAM6 and HAM7.
Today's activities: - The RGA tree at EX was leak-checked, and multiple flanges were leaky, possibly because of some overheating during a bakeout in the past. The gaskets will be redone, and the all-metal angle valve will be also replaced - EX was vented - The VPW vacuum chamber was opened, after the 2 stuck screw was removed - Both 2 spare roughing stations are entirely finished - All the Hepta header filter works were finished in the LVEA

Measured the purge air dew point at the corner station with no usage from other groups, no people in chamber, measured -41.3 degrees C.

Measured the purge air dew point at EX, no open ports, before vent, measurement was done at the purge valve area, measured -45.4 degrees C.
[Rahul, Keita, Betsy, Koji]
Preparation work to extract the existing OMC has been completed. We will continue with the OMC extraction tomorrow morning.
The overall work procedure for the OMC replacement is summarized in G231106 https://dcc.ligo.org/LIGO-G231106.
= OMC shroud panel removal =
While waiting for the beam from the squeezer to come, we started the removal of the OMC shroud panel in parallel. The work was done along with the procedure E1600164.
The removed panels were placed on a stainless steel table in the HEPA booth of HAM6 (Attachment 1). The panels were not covered to prevent accidental placement of objects on them.
During the work, a beam dump was removed from the table to make the removal work possible. This beam dump is to kill one of the weak transmissions of the OMC.
Betsy took the photo record of the location, but it is safely trivial how it should be aligned.
= SQZ beam marking and alignment =
The beam was delivered to HAM6 and was pinned down with two irises on the ISI table.
The irises were placed just after the beam entered HAM6 (next to OM2) and just before OM1 (next to the fast shutter).
This means that these indicators are not affected by the alignment in HAM6.
They were placed by eyeballing, so their precision was as such. By default, both the irises were set to the maximum opening.
Next, the beam alignment was servoed towards the WFS heads using the DC centering ASC loops.
As soon as the control was applied, both QPDA and QPDB of OMC showed significant signals with total light level of ~1e-3 (Attachment 2).
When the light was blocked (at the squeezer?), the value dropped to almost zero, confirming that this was a real beam.
This is very good news as we'll be able to find the beam arrival using the OMC QPDs when we try to align the new OMC.
= Holding suspension mass =
Next, we proceeded to hold the suspension masses. Rahul and Koji worked in the chamber on the ISI table for the following operations.
To hold the intermediate mass:
Then, moved onto fixing the OMC:
= Removing the electronic cables from the OMC =
Upon removing the electronics cables, one person held the cable harness on the OMC breadboard to prevent the OMC from wobbling too much.
The removed cables were wrapped around the top part of the suspension frame to keep them out of the way of the further work.
At this point, it was just at 5pm, so we exited from the chamber.
Next Steps:
